I-95 Interchange Project

Traveling Construction I-95 Interchange Project

PA Turnpike/I-95 Interchange Project

  • Project Overview
  • Design & Construction Details
  • News & Public Involvement
  • Team & Contact Info

PA Turnpike/I-95 Interchange

I-95 Interchange Staging Map

The Pennsylvania Turnpike/Interstate 95 Interchange Project now directly connects these two highways. One of the goals of this project is to reduce congestion on local Bucks County roadways as well as improve the flow of traffic in the Philadelphia region and along the entire east coast.

This website will inform the public with timely and accurate construction information to improve travel while using the Pennsylvania Turnpike and Interstate 95 in the Bucks County area.

Keeping the public informed of construction activities will enable safe and expeditious travel through the construction zones.

For additional information on this project, including the latest design information, please click on the appropriate links in the menu at the top.

Project Status

The PA Turnpike/I-95 Interchange Project now directly connects the PA Turnpike and Interstate 95, thus making Interstate 95 continuous throughout the Mid-Atlantic Region.

The Preliminary Design Phase was Completed in 2008. All Final Design and Construction activities for Stage 1 elements were completed in 2021. The schedule of construction for Stage 2 and Stage 3 elements is largely dependent on funding.

Section D30 construction began in August 2023 and will reconstruct and widen the turnpike to three lanes in each direction between Bensalem Boulevard and the I-95 flyover connection. Click the button below to view more information on Section D30.

Click the Design & Construction button for more information about the entire PA Turnpike/I-95 Interchange project.

Section D30 Info

Design & Construction

Contact Us

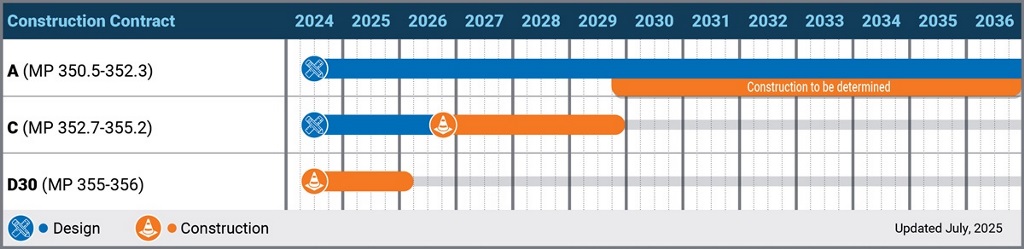

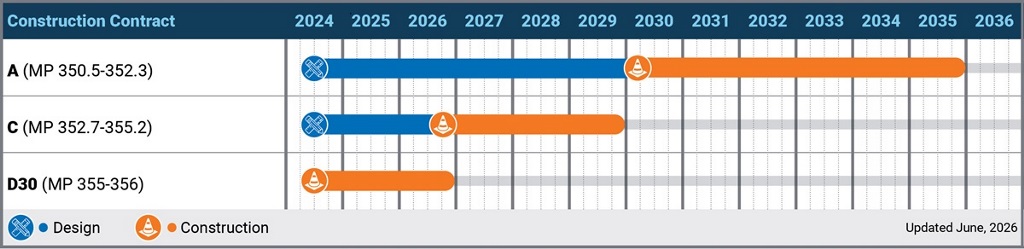

Project Schedule

schedule of all projects

Project History

In 1969, Interstate 95 was completed without a direct connection to the Pennsylvania Turnpike, which had been constructed more than 10 years prior. The lack of a direct connection has created confusion for regional travelers and resulted in increased congestion on local arterial roadways used by motorists to connect between the interstate highways.

Several previous studies in the 1970s and 80s have suggested ways to join these two roads but were discontinued for a variety of engineering and environmental reasons. The goal of the latest environmental impact study, completed in 2003, was to determine whether a direct connection could be developed between the PA Turnpike and I-95, while minimizing impacts on socioeconomic and environmental resources.

The objectives for the Interchange Project:

  • Provide an improved linkage between the PA Turnpike and I-95 for easier interstate travel
  • Complete I-95 through the Mid-Atlantic region by constructing an interchange and redesignating the PA and NJ Turnpikes
  • Reduce the amount of traffic on local roads currently used to make the connection between I-95 and the PA Turnpike
  • Increase the capacity on the PA Turnpike and I-95 to accommodate the transfer of traffic from the local roads to the interstates
  • Improve travel time through the study area by reducing traffic delays

Historical Timeline

For more specific updates, including progress photos, please see our Design & Construction page.

December 2021

New Falls Road Bridge replacement completed.

December 2020

Route 13 Connector completed.

September 2018
Flyover structures are open to traffic.

August 2018
Hulmeville Road bridge reconstructed.

2017
Section D10 completed.

2016
Tolling conversion to Neshaminy Falls toll plaza and Westbound Cashless Tolling point implemented at the Delaware River Bridge. Section B completed.

2015
Bensalem Boulevard Bridge reconstructed.

2013
Wetland mitigation and stream mitigation sites completed. Richlieu Road and Ford Road bridges reconstructed. Section B construction began.

2011
Galloway Road and Bristol Oxford Valley Road bridges reconstructed.

2009 - 2010
Final Design underway. Stage 1 construction began.

2004 - 2008
Preliminary Design completed.

2004
The PA Turnpike Commission receives authorization of federal funds for the project's design. Design for the interchange project is initiated.

1992-2003
PA Turnpike Commission studied a high-speed, direct interchange between the PA Turnpike and I-95. The Final Environmental Impact Statement (FEIS) is completed, evaluating the various design alternatives and their potential impacts and documenting the preferred alternative. The Record of Decision (ROD) is issued by the U.S. Department of Transportation's Federal Highway Administration (FHWA), approving the preferred alternative identified in the FEIS. Download the Record of Decision.

1984-1988
PA Turnpike Commission studies a slow-speed, conventional interchange between the PA Turnpike and I-95 (see map, Scheme B). Engineers conclude this interchange is inadequate once updated traffic volumes are generated for the project.

1985
PA Act 61 authorizes the PA Turnpike Commission to construct many projects throughout the state including an interchange between the PA Turnpike and I-95 in lower Bucks County and Turnpike widening from Valley Forge to the Delaware River.

1982
The Federal Surface Transportation Assistance Act specifies that I-95 be completed through a PA Turnpike/I-95 interchange which would connect to the NJ Turnpike using the Delaware River Bridge.

1975-1977
PA Department of Transportation (PennDOT) studies a connection between the PA Turnpike and I-95 through Silver Lake and Delhaas Woods in Bristol. No further studies are conducted due to potential major environmental impacts.

1969
I-95 is completed through Bucks County. The original plan included ways to interchange between the PA Turnpike and I-95, but federal funds were not permitted to be used to directly connect an Interstate highway to a toll road, under federal laws and regulations of that period. (The federal laws have since been modified to permit such a project.)

1954-1956
Delaware River extension of PA Turnpike and Delaware River Bridge is completed.

Frequently Asked Questions

What are the details of the three project Stages?

In 2010, the PA Turnpike/I-95 Interchange Project was split into three stages. Stage 1 was completed in 2021. Select Stage 2 contracts have been constructed wholly with PA Turnpike funds. Select remaining portions of Stage 2 are currently under Final Design. Stage 3 is currently in an Alternative Analysis phase and will move into Preliminary Engineering in 2024.

Stage 1 work included:

  • Construction of environmental mitigation sites
  • Advanced and work zone Intelligent Transportation Systems (ITS) deployments
  • Replacement of four overhead bridges (three over the Turnpike and one over I-95)
  • Construction of new a Neshaminy Falls toll plaza in Bensalem and a new Delaware River Bridge Cashless Tolling Point (westbound only)
  • Flyover ramps connecting I-95 mainline to the Turnpike with associated highway widening
  • Reconstruction of the Delaware Valley Interchange Connector Ramp with a new at-grade intersection at Route 13

Stage 2 work includes:

  • Replacement of three additional overhead bridges, all of which are completed
    • Bensalem Boulevard
    • Hulmeville Road
    • New Falls Road
  • Replacement of the ramp bridge over the Turnpike mainline at the Bensalem Interchange (completed as Section A1)
  • Completing the remaining reconstruction at the Bensalem Interchange (Section A)
  • Mainline widening along the remaining portions of the PA Turnpike (Sections C & D30)
  • The six remaining interchange movements connecting I-276 to I-95/I-295 (Section D40)

Stage 3 work includes reconstruction of the existing bridge over the Delaware River between Pennsylvania and New Jersey and their approaches.

Is there an installation plan for noise walls? How are they maintained and funded?

Noise walls will be installed in areas where they are feasible, reasonable, and warranted. Please watch our Noise Wall video to learn more about how the PA Turnpike determines where noise walls will be located.

When noise walls are proposed, public outreach is conducted to help select the color and texture of the noise walls. Once selected, their construction is tied to the timeline of the widening effort, which is currently scheduled for completion by the end of 2026. Therefore, installation of the noise walls is anticipated to occur in conjunction with that project, and the duration of construction will be determined as part of the overall widening schedule. Please refer to the project schedule above.

The noise walls installed within the PA Turnpike's right of way are fully funded and maintained by the Pennsylvania Turnpike Commission.

Who can I contact about property impacts such as standing water, fencing, vegetation/tree removal, and debris? Are there precautions to prevent mosquito breeding in standing water areas, and is stormwater management included in the design plans?

If you have questions or concerns about the construction project, you can contact Jacobs Engineering, the Design Manager, at 215-355-3577.

When necessary, the PA Turnpike will initiate preventative measures during the summer construction months to inhibit the breeding of mosquitoes in the standing water areas within the construction zone. The brand of mosquito extermination product that will be used has been approved by the Bucks County Conservation District. The bacterium in the product effectively eliminates mosquito larvae, yet is harmless to other living things including pets and wildlife. This mosquito treatment will be used only on the temporary sedimentation basins within the construction zone and only during the construction phase. Once complete, the permanent stormwater basins within the project area are designed to regularly release water before mosquitoes can breed. Therefore, the permanent basins will not require preventative mosquito treatment.

The Design Team continues to coordinate with the appropriate environmental agencies regarding stormwater management. The stages of this project will adhere to the latest local and state government guidelines for controlling runoff from the project. Also, wetland restoration and stream enhancement has taken place to mitigate for project related impacts.

Aside from the new Interchange between I-95 and the PA Turnpike, will there be any new interchanges or exits constructed along I-95 or the PA Turnpike?

No. The only new interchange associated with this project is the newly opened highway speed interchange between I-95 and the PA Turnpike. Interstate access to the local road system will still be via the existing Turnpike and I-95 interchanges in the project area.

What is All Electronic Tolling?

All Electronic Tolling allows all customers to pay without stopping at tollbooths. The PA Turnpike Commission introduced All Electronic Tolling on the PA Turnpike system in one location in January 2016. This tolling point, westbound over the PA Turnpike Bridge at the Delaware River, does not accept cash, but instead uses two easy payment options: E-ZPass or PA Turnpike TOLL BY PLATE. More information can be found at All-Electronic Tolling.

Now that the PA Turnpike/I-95 Interchange is complete, do I have to pay a toll when traveling north or south on I-95?

Vehicles traveling from New Jersey to Pennsylvania are required to pay a one-way vehicle-based toll for crossing the bridge over the Delaware River. This toll is collected via the Turnpikes new Cashless Tolling system. Vehicles crossing the bridge over the Delaware River from Pennsylvania to New Jersey are not charged. Now that the flyovers are complete, motorists can travel between the PA 413 and US 13 Interchanges toll free in both directions.

How will construction of this project affect local road conditions, including road closures and detours? How will traffic be impacted on the PA Turnpike and I-95? Will there be night work?

At least two lanes of traffic in each direction on the PA Turnpike and I-95 will remain open throughout the entire construction period, with the exception of limited planned nighttime and required off-peak lane closures. The construction of all seven overhead structures has been completed.

Based on the significant volume of work needed to complete the project on time, there will be occasional work at night. This type of work includes heavy machinery and multiple light trucks/devices. Additionally, as part of the contract for this and all Turnpike projects, all construction work requiring lane closures is predominantly conducted at night to accommodate the heavy volume of daily commuters on the Turnpike.
