Quakertown Interchange

Quakertown Interchange

Quakertown Interchange reconstruction and reconfiguration.

  • Project Overview
  • Design & Construction Details
  • News & Public Involvement
  • Team & Contact Info

Project Overview

This project will reconstruct and widen 1.5 miles of the Pennsylvania Turnpike from milepost A43 to milepost A44 in Milford Township, Bucks County. The roadway will expand from four lanes to six lanes, with three 12-foot wide travel lanes in each direction, a 26-foot median, and 12-foot shoulders.

The project also involves reconstruction of the Quakertown Interchange, which includes the addition of new ramps, the replacement of the bridges carrying SR 663 over the PA Turnpike and Molasses Creek, and the reconstruction of SR 663 within the interchange. Maintenance access ramps will be constructed at Kumry Road and Steinsburg Road.

Upon completion, this reconstruction and widening will enhance safety and mobility for travelers on this section of the interstate.

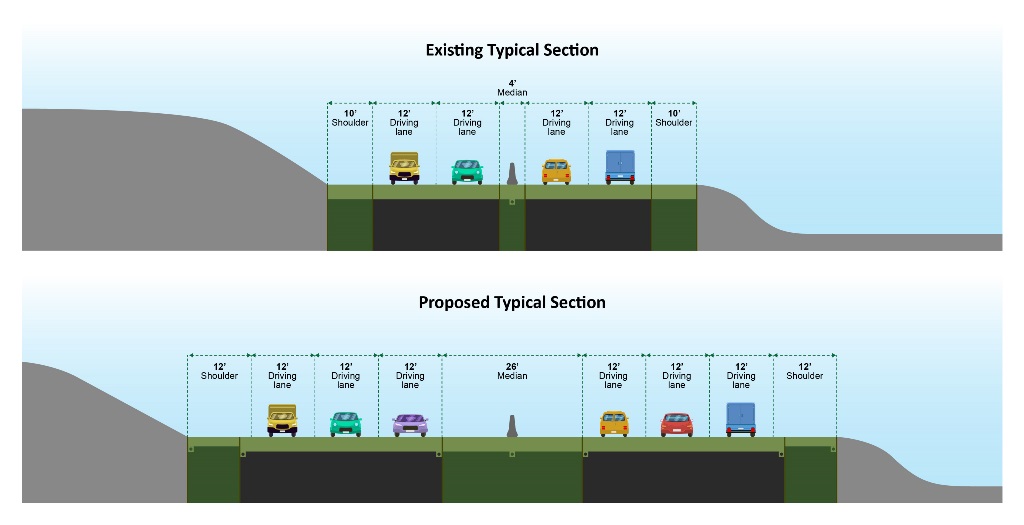

Typical Roadway Sections

Typical Sections Graphic

At project completion, the section will consist of 6 travel lanes (3 westbound and 3 eastbound), with a 26-foot median, and 12-foot outside shoulders.

Roadway image

Project Maps

Project Activity Map

Project Area Map

Location Map

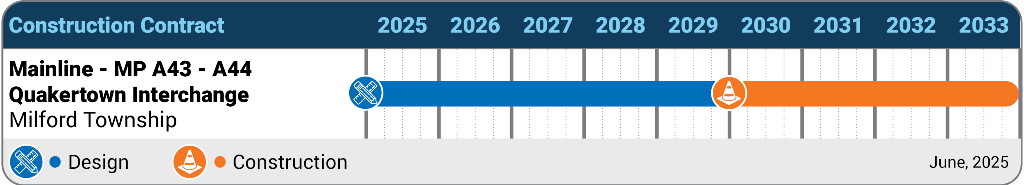

Project Schedule

Design schedule

Frequently Asked Questions

This stretch of highway is already heavily congested and will be even more so once construction begins. What is the PTC going to do to relieve congestion throughout construction?

During peak travel times between 6:00 a.m. and 6:00 p.m. two lanes of traffic will be maintained in both directions. Exceptions include emergency roadway repairs and daytime work performed by Turnpike Maintenance requiring a lane closure. Once construction begins, widening will occur to the outside lanes first; traffic will then be shifted to the new roadway as construction continues on the remaining inside lanes. Dynamic Message Signs will be installed at key locations prior to the start of roadway construction in order to provide motorists advance notice of incidents and to inform motorists well in advance of the incident location so they can prepare to exit the Turnpike if necessary.

Does the PTC expect to continue widening to the north?

Yes. Preliminary design is progressing on the reconstruction and widening of the Northeast Extension between mileposts A44 and A57 (just north of and including the Lehigh Valley Interchange).

Will tolls have to be increased to pay for this project?

No. The Turnpike does not raise tolls to fund individual projects.

How much will the project cost?

The estimated cost is still being developed.

How is this project funded?

The project is funded entirely by Turnpike toll dollars, with no federal funds or state tax dollars involved.

What are you doing to protect the environment?

The PTC continues to work with local, state and federal regulatory agencies such as the Bucks County Conservation Offices, the Pennsylvania Department of Conservation and Natural Resources, the Pennsylvania Department of Environmental Protection, the Pennsylvania Fish and Boat Commission, the US Army Corps of Engineers, and local special interest groups to make sure the project is completed with the least impact to the existing environment.

How did the PTC determine where the sound barriers will be located?

Engineering noise studies will be conducted during the design process. At this time it has not been determined if sound barriers will be warranted.

Will the local roads crossing the Turnpike be impacted during construction?

John Fries Highway (SR 663) will remain open to traffic during construction but is expected to have long term lane restrictions as the bridges are replaced in stages. Steinsburg Road, although in the project area, was previously reconstructed and lengthened and will not be impacted with this project.

When is construction expected to begin and how long will it take to complete?

The project is planned to start following completion of the MP A38-A43 project currently under construction. The current plan is for the MP A43-A44 to start in 2030 or later and is expected to take four years to complete.

Why is this project being built?

This project is part of the Pennsylvania Turnpike Commission’s (PTC) $2 billion system wide total reconstruction initiative which entails rebuilding sections of the 60-plus-year-old Turnpike’s Northeast Extension from the ground up. The new roadway design meets current interstate design standards and will provide a safer and more efficient travel experience for Turnpike customers. The existing pavement conditions, current traffic volumes and projected growth dictate widening the mainline from four to six lanes. The existing Quakertown Interchange ramps will also be reconstructed. Because the PA Turnpike will be converting to Open Road Tolling prior to the reconstruction, the existing Toll Plaza will be removed and additional ramps will be added to facilitate traffic volumes.
