Delaware River Bridge Project

PA Turnpike/I-95 Interchange Project - Stage 3

The Pennsylvania Turnpike Commission (PA Turnpike) and the New Jersey Turnpike Authority (NJTA), with oversight from the Federal Highway Administration (FHWA), are currently evaluating rehabilitation and replacement options for the existing Delaware River Bridge (DRB).

Looking Back

The previously selected alternative from the 2003 Record of Decision (ROD) was to build a new bridge to carry eastbound (i.e. I-95 NB to NJ) traffic and rehabilitate the existing bridge to carry westbound (i.e. I-95 SB to PA) traffic.

In 2017, a fracture of one of the existing bridge approach trusses required a full closure of the bridge for more than six weeks while the bridge was fully inspected and repaired.  The closure resulted in extensive detours for the approximately 68,900 daily vehicles traveling this section of I-95.  As a result of the closure, the tolling agencies have programmed funding for the DRB project to complete an Alternatives Analysis, Supplemental Environmental Impact Statement (SEIS) under the National Environmental Policy Act (NEPA), and Preliminary Engineering.

Environmental Review

A SEIS is required if changes to the proposed action would result in significant environmental impacts not evaluated in the original EIS; or new information or  circumstances relevant to environmental concerns, bearing on the proposed action or its impacts, would result in significant environmental impacts not previously evaluated.  As part of the SEIS process, a full range of alternatives is being considered both north and south of the existing bridge. Additionally, the Team must consider whether the existing bridge can still be rehabilitated, which was part of the 2003 selected alternative.

The SEIS follows the same process and format as that of an Environmental Impact Statement (EIS). While it builds off the original 2003 FEIS and ROD, the SEIS for the DRB project will be prepared based on updated information and analyses, public involvement, and agency coordination. In other words, the SEIS provides the opportunity for a ‘fresh look’ at the project. The FHWA will issue a Final SEIS and ROD that will document the rationale for the selected alternative.

Moving Forward

The Team is currently conducting an Alternatives Analysis which evaluates rehabilitation and replacement alternatives and bridge types for the DRB project.  An Alternatives Analysis Report will be prepared to document the analysis and identify proposed alternatives to be advanced for detailed study in the SEIS. The proposed alternatives will be made available for public and agency consideration and feedback prior to finalizing.

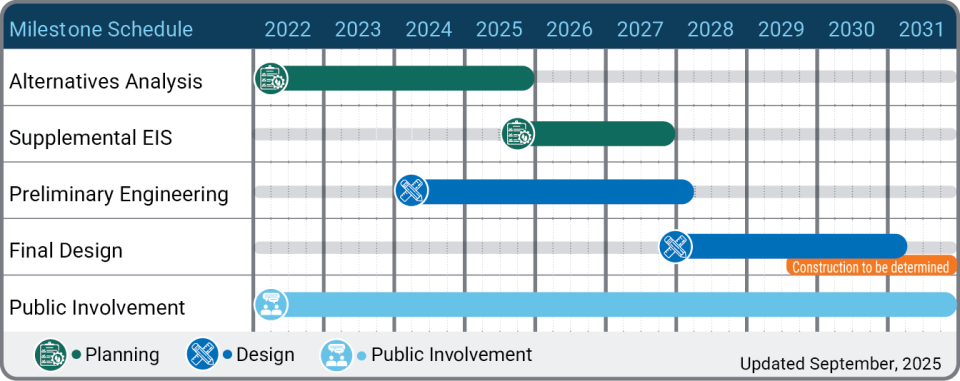

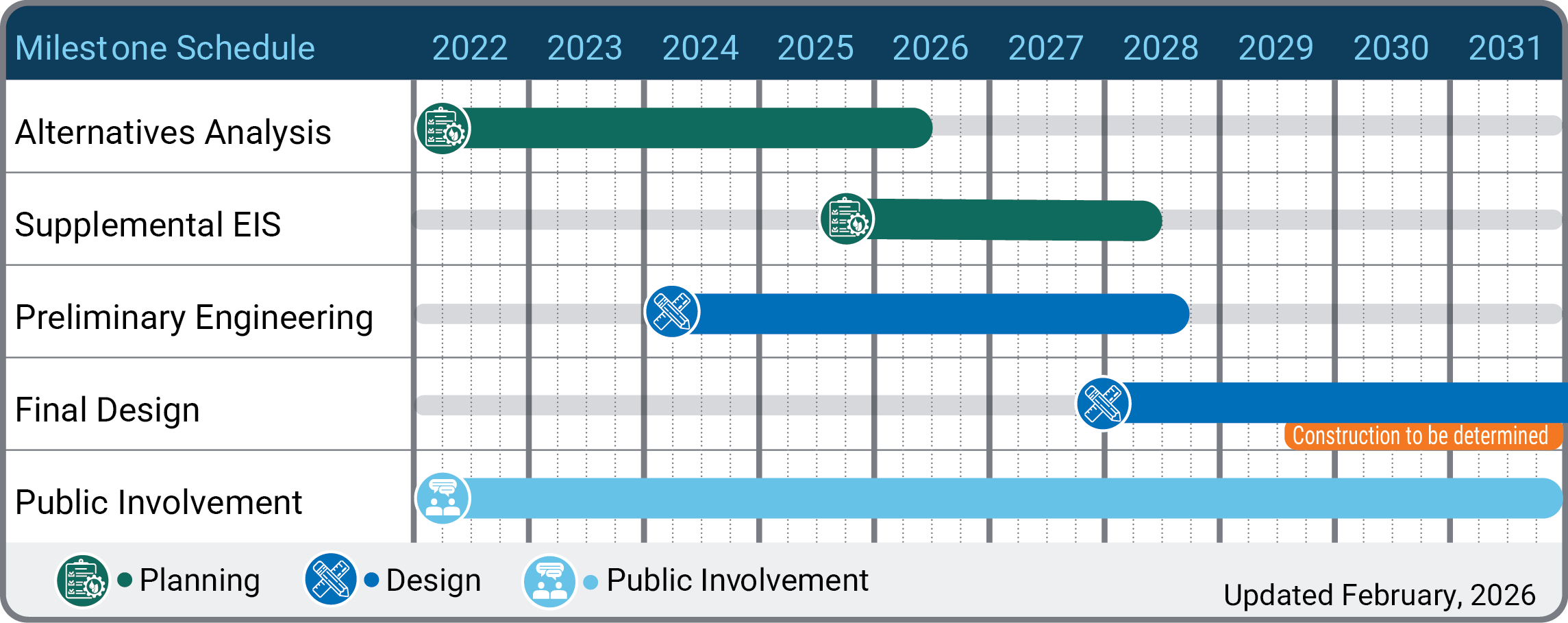

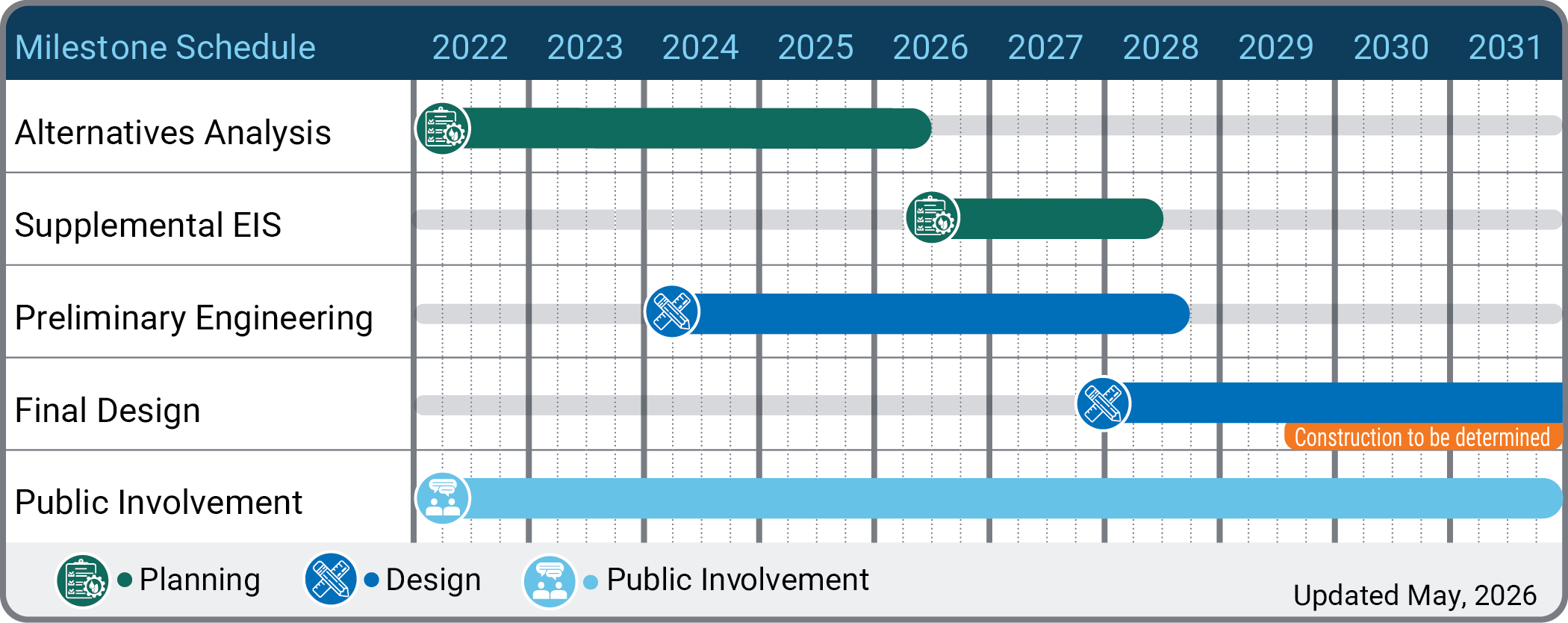

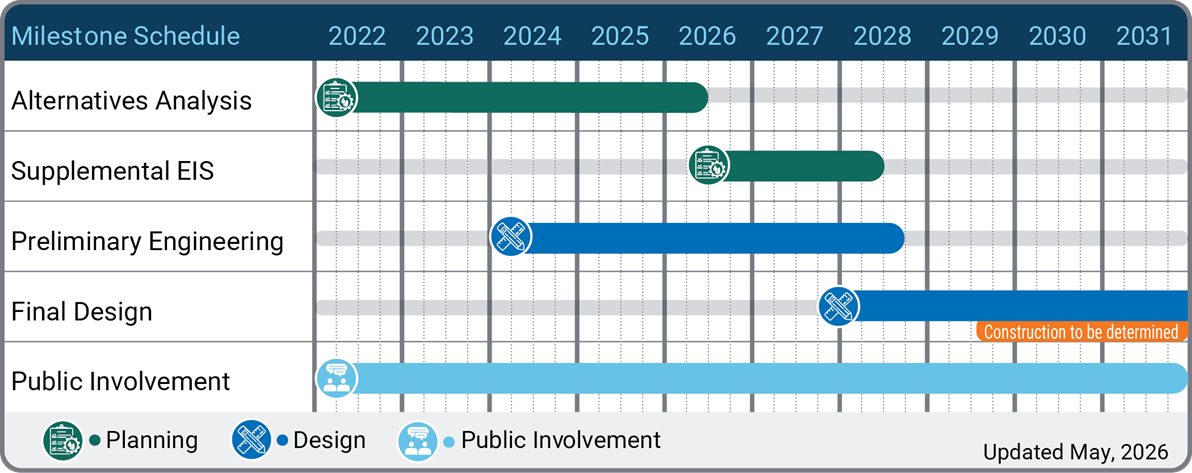

When the Alternatives Analysis is complete and the determination for rehabilitation or replacement is made, preliminary design activities will continue into 2027. The SEIS will concurrently evaluate changes since 2003 for the range of alternatives, assess impacts, and obtain input from federal, state, and local regulatory agencies and the public.

Once preliminary engineering and environmental clearance are complete, the next steps are to complete final design, permitting, and construction.

This logo shows the partnership among the PA Turnpike Commission, New Jersey Turnpike Authority and Federal Highway Administration

Public Meeting Open House

Participate in one of the upcoming public meetings in October.

More Details

Scroll Down for More Info

Project Study Area Map

FAQs

More Project Resources

Join the Delaware River Bridge Mailing List

Project updates will be sent directly to your inbox.

Sign Up Today

More in Design and Construction

  • I-95 Interchange Project

Project Study Area Map

The following map shows the project study area which includes Bristol Borough and Bristol Township in Bucks County, PA, and Burlington Township and Florence Township in Burlington County, NJ.

The study area boundary is for planning purposes only and does not indicate property impacts. (Click here to enlarge the map)

Delaware River Bridge Project Study Area Map

Frequently Asked Questions

Are there opportunities for biking and pedestrian improvements?

The project team is investigating potential improvements to existing trail facilities in both PA and NJ as a part of the DRB Project. The improvements will consider connections in and around the bridge. Regarding the potential for a multi-use facility on the structure itself, please note that the DRB carries I-95, a limited-access highway that is part of the Interstate Highway System. Pedestrians and bicyclists are not permitted to operate on I-95 in either state. Further, cyclists and pedestrians are prohibited from operating on the PA Turnpike and NJ Turnpike.

Will tolls increase because of this project?

No. The owners do not raise tolls to fund individual projects.

When will property impacts be identified?

Property impacts will be identified during the Final Design phase of the project after Preliminary Engineering and Environmental Clearance are complete. Final Design is currently targeted to begin in 2028.

What are the field crews in my neighborhood working on?

The Team is currently re-evaluating all existing conditions in the study area. This work includes a multitude of tasks such as surveys, environmental studies, geotechnical investigations, and more. If property access is required, the property owner will be notified in advance.



Will the public be included in the process and have an opportunity to comment on the Supplemental Environmental Impact Statement (SEIS)?

Yes. Opportunities to provide feedback and get updates on the results of the Alternative Analysis, Preliminary Engineering, and SEIS will be provided through public meetings, stakeholder meetings, public surveys, project updates, and public hearings. Public meetings/hearings will be held in both New Jersey and Pennsylvania. Please Join the mailing list today or go to the Contact Us page to request a meeting in your community.





When will the new alternative be selected?

To select an alternative, Preliminary Engineering and environmental clearance must be completed and public input must be considered. The target date for that decision is 2027.

What happens during the Preliminary Engineering (PE) phase?

During the PE phase, a variety of engineering activities, concurrent with the environmental activities referenced above, occur to assess alternatives. Fieldwork and investigations will occur through 2026. The majority of residential properties requiring survey will most likely be surveyed from the street side and will require minimal access to the actual property. If property access is required, the property owner will be notified in advance

Is the Delaware River Bridge safe?

Yes. The bridge undergoes a comprehensive safety inspection every two years. The inspections performed follow National Bridge Inspection Standards to maintain safe bridge operations. The U.S. Department of Transportation sets the standards and works through FHWA to implement them.

The bridge owners use the information from the inspections to maintain and repair the bridge as necessary.

Why has there been a change to the original preferred alternative that was selected in 2003?

The general design in the approved 2003 Environmental Impact Statement (EIS)/Record of Decision (ROD) was a newly constructed parallel bridge to the south of the existing bridge to accommodate eastbound traffic destined for New Jersey and rehabilitation of the existing bridge to accommodate westbound traffic into Pennsylvania. After the 2017 fracture repair and comprehensive inspection, and considering the age of the 2003 environmental documentation, a new Alternatives Analysis that explores a full range of alternatives was required. In addition, FHWA has also requested a Supplemental Environmental Impact Statement (SEIS) be completed which is currently underway.
