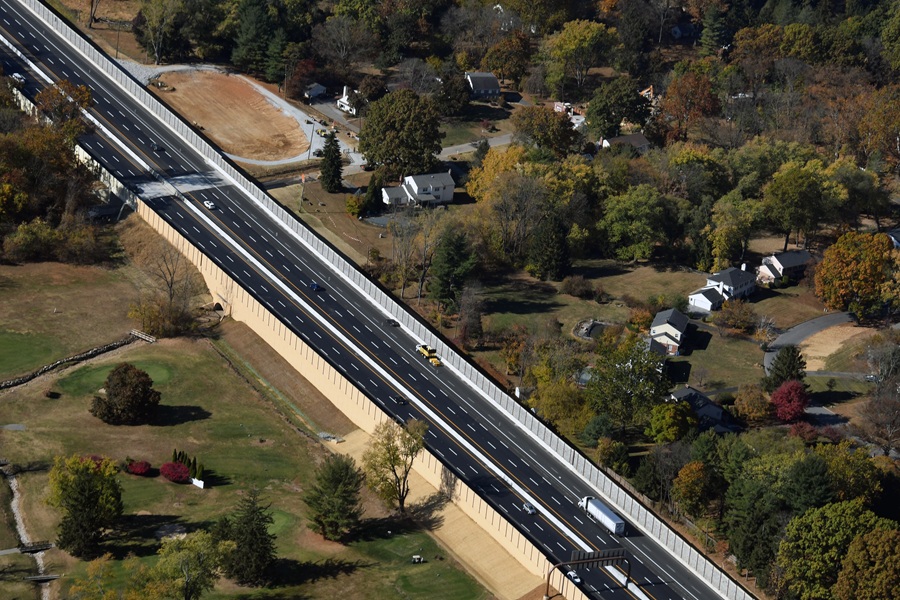

January 2025 - The Turnpike was reopened in October 2024 to six lanes of traffic

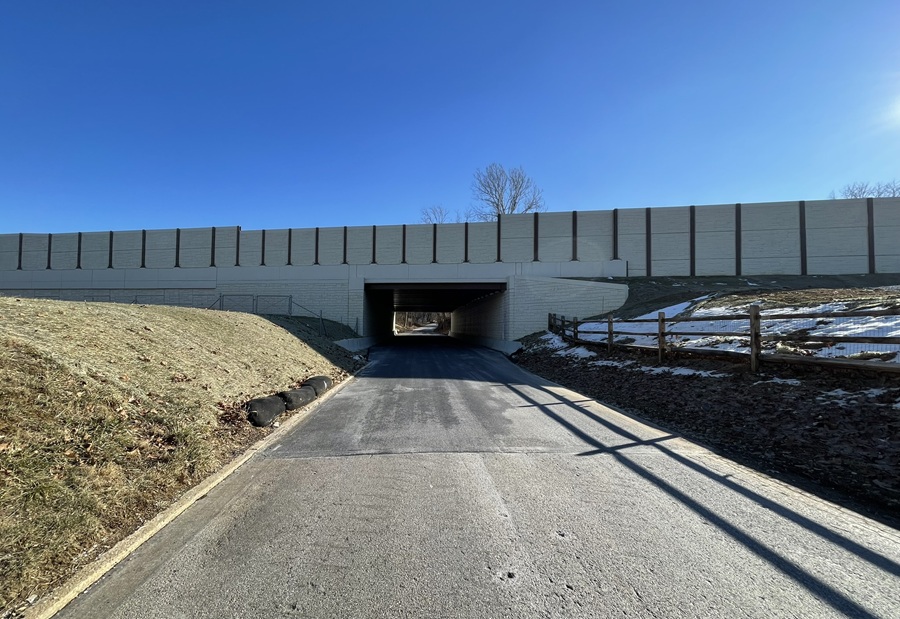

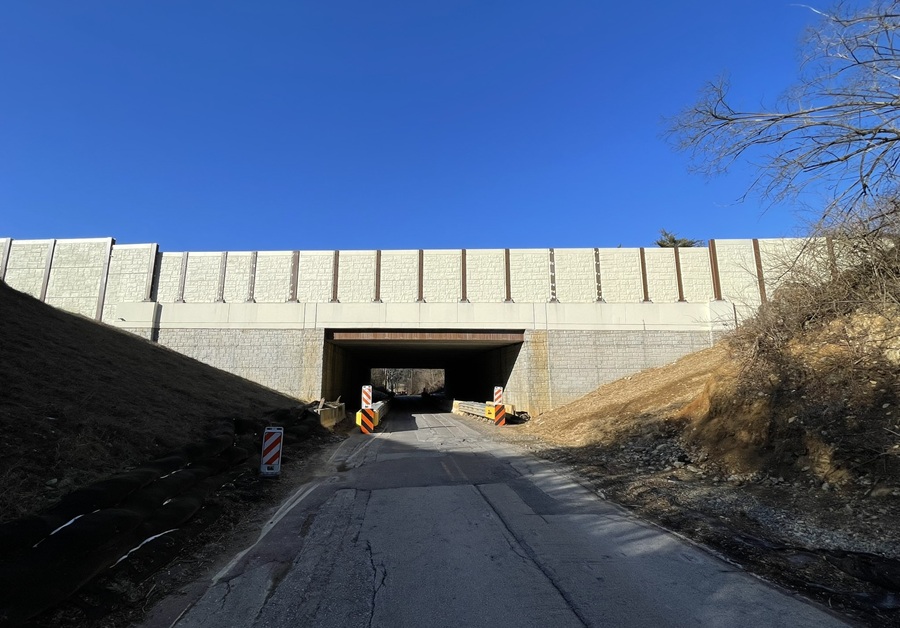

January 2025 - The completed new bridge carrying the Turnpike over Glenhardie Road
January 2025 - The completed new bridge carrying the Turnpike over Thomas Road

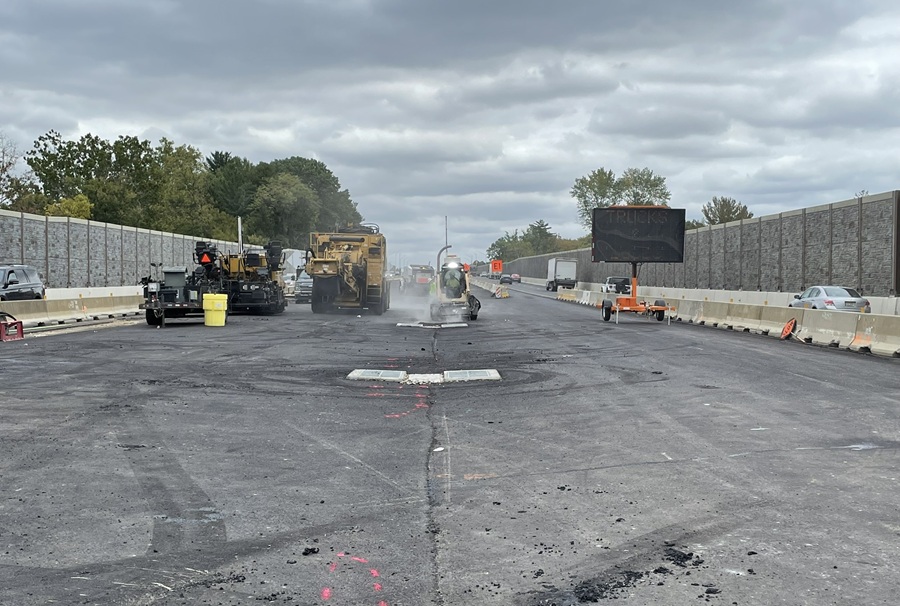

September 2024 - A work crew paves the center area of I-76

September 2024 - Tarps are used during the concrete curing process on the new bridge over U.S. 422 and N. Gulph Road

September 2024 - A portion of the center area of the Turnpike with new pavement

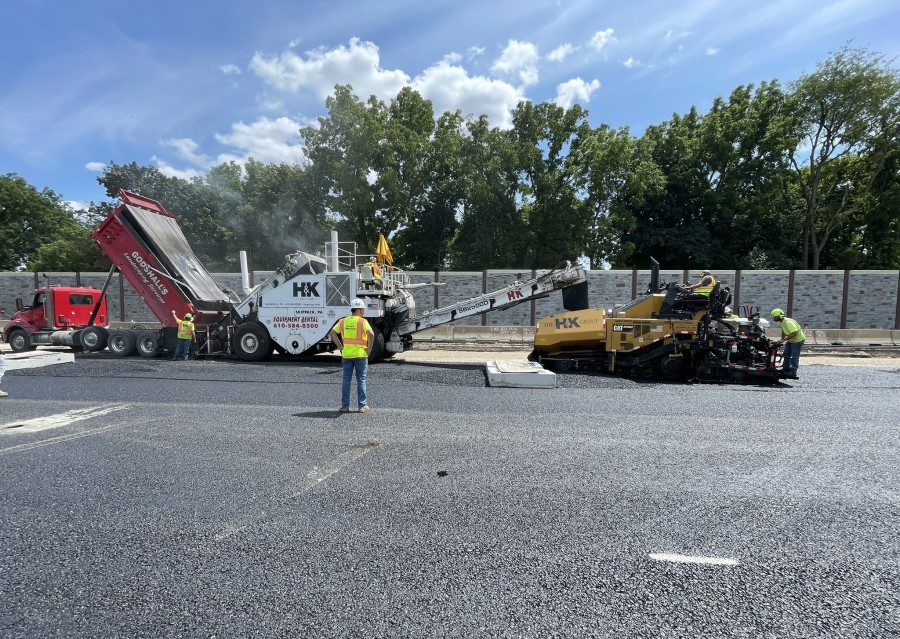

August 2024 - New pavement in the center area of I-76

August 2024 - Workers place the concrete deck on the new bridge over Thomas Road
August 2024 - Workers install deck pans on the new bridge over U.S. 422 and N. Gulph Road

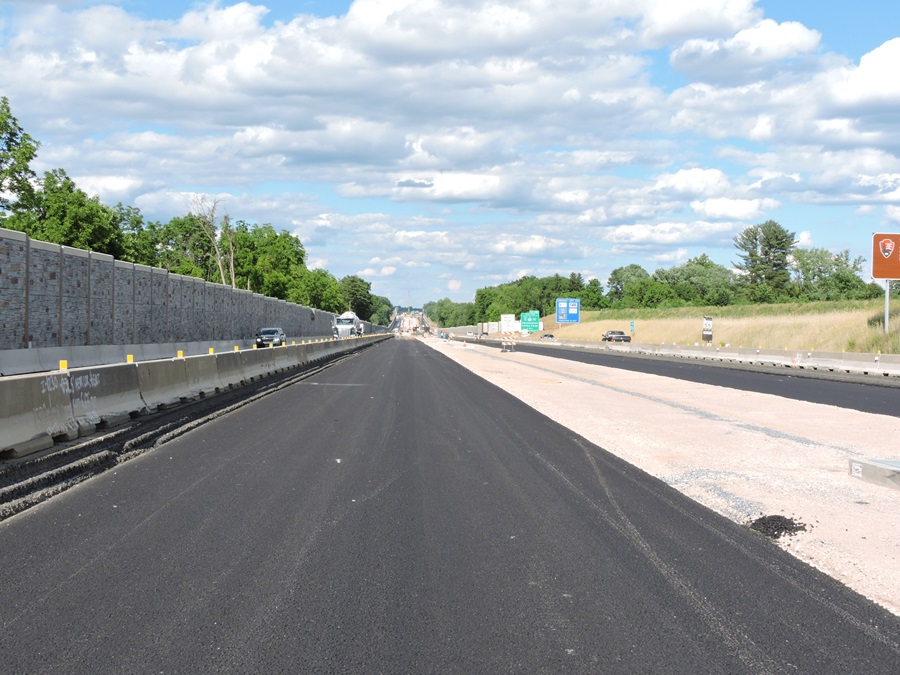

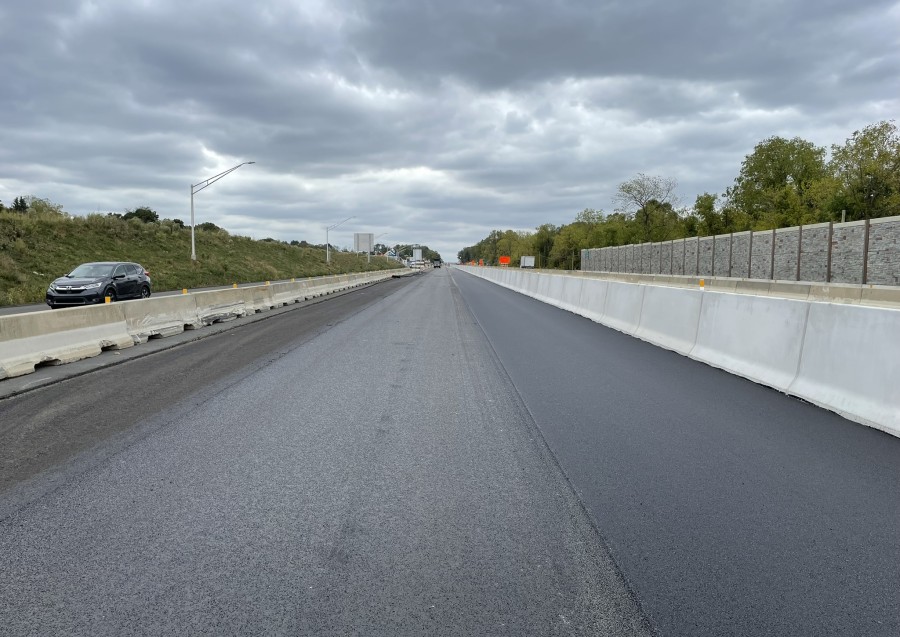

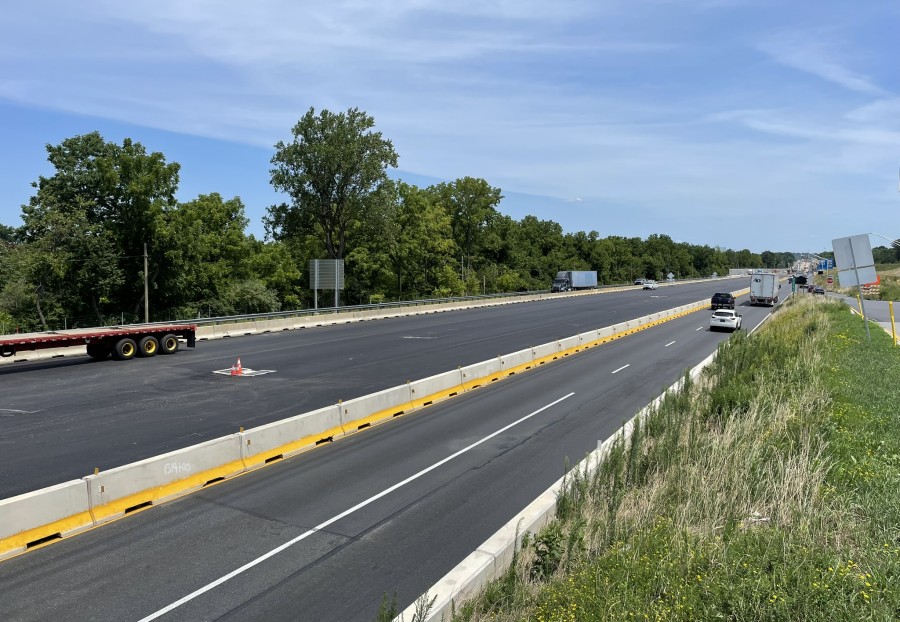

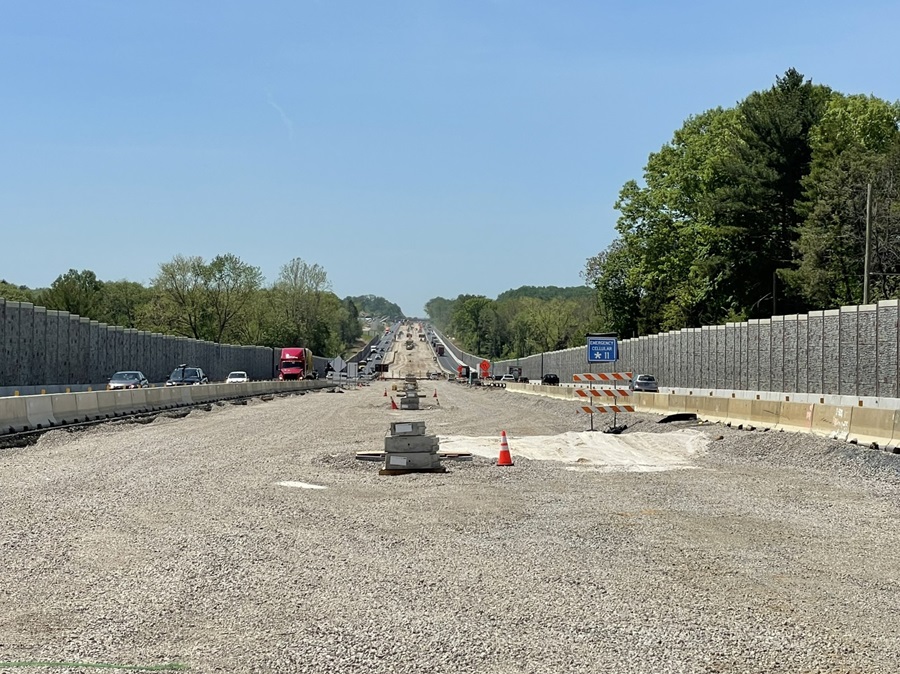

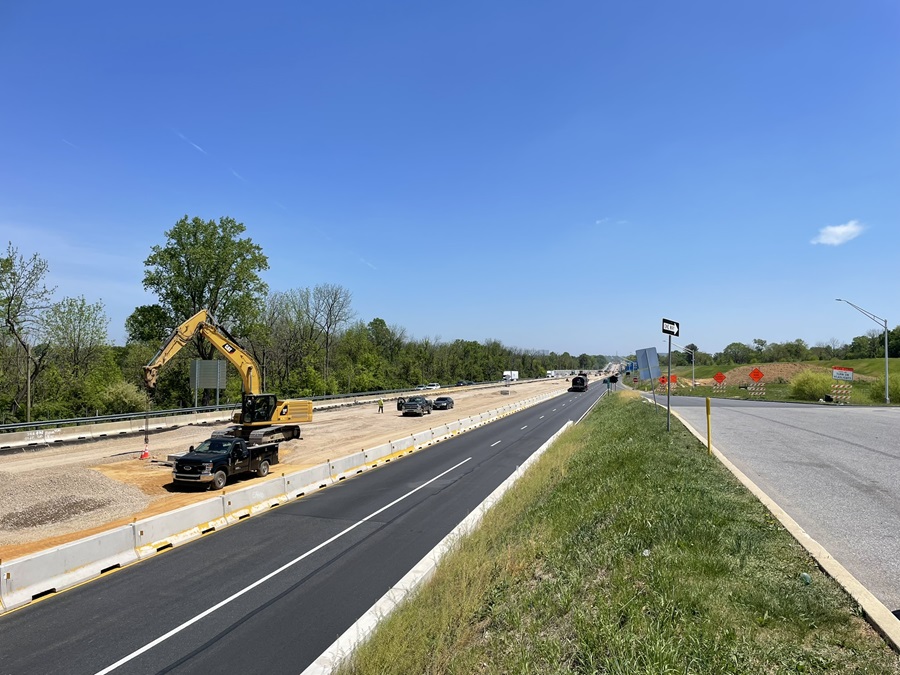

July 2024 - The freshly paved center area at the Valley Forge Interchange

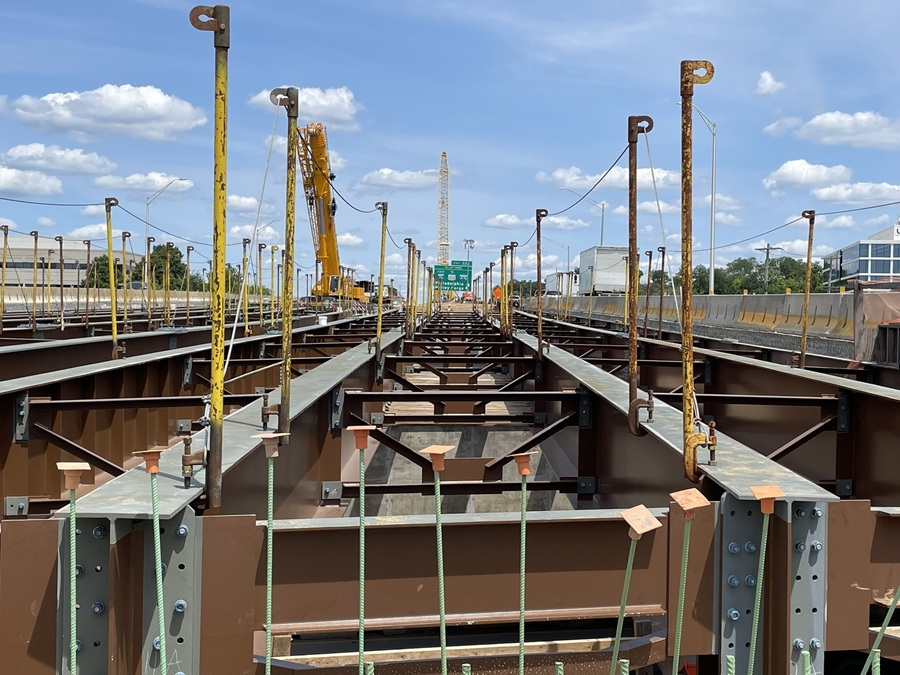

July 2024 - Deck beams in place on the new bridge over U.S. 422 and N. Gulph Road
July 2024 - A work crew paves the center area of I-76
May 2024 - Center area Turnpike paving

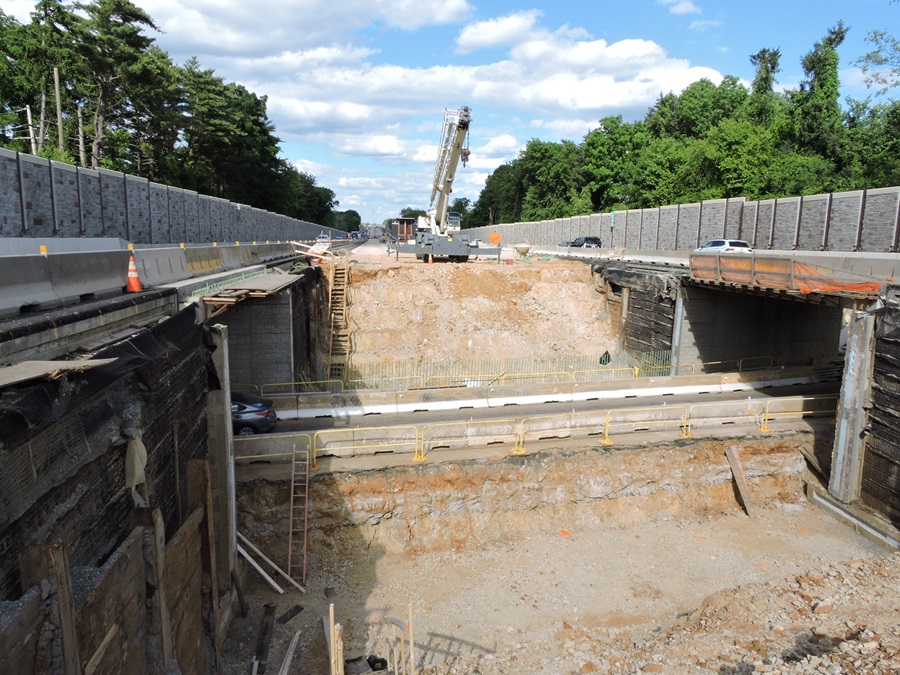

May 2024 - Constructing the center area of the bridge over Thomas Road
May 2024 - Construction of the new bridge over U.S. 422/N. Gulph Road
May 2024 - Center area construction at the Valley Forge service plaza

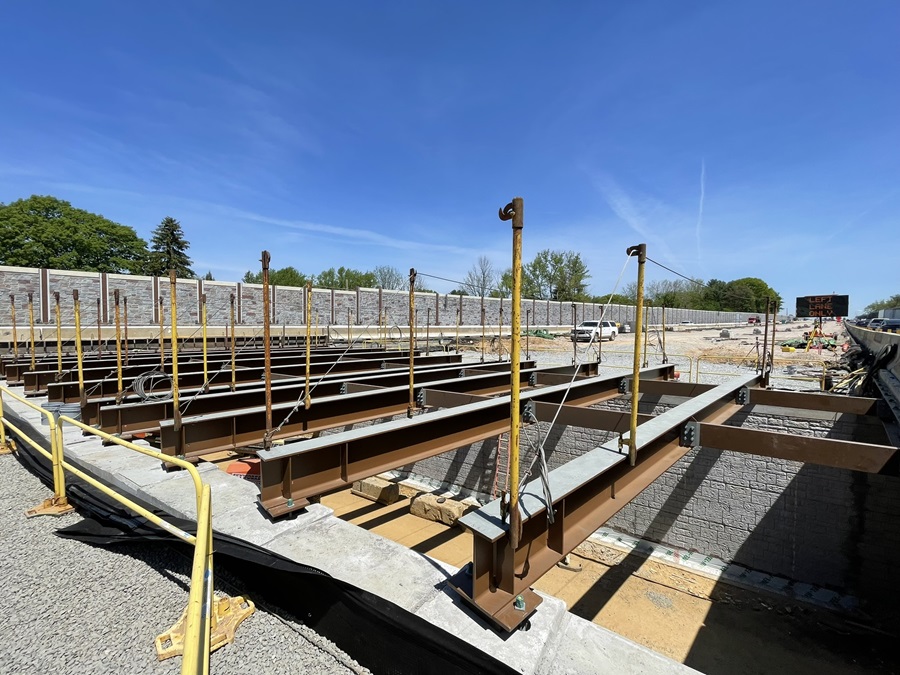

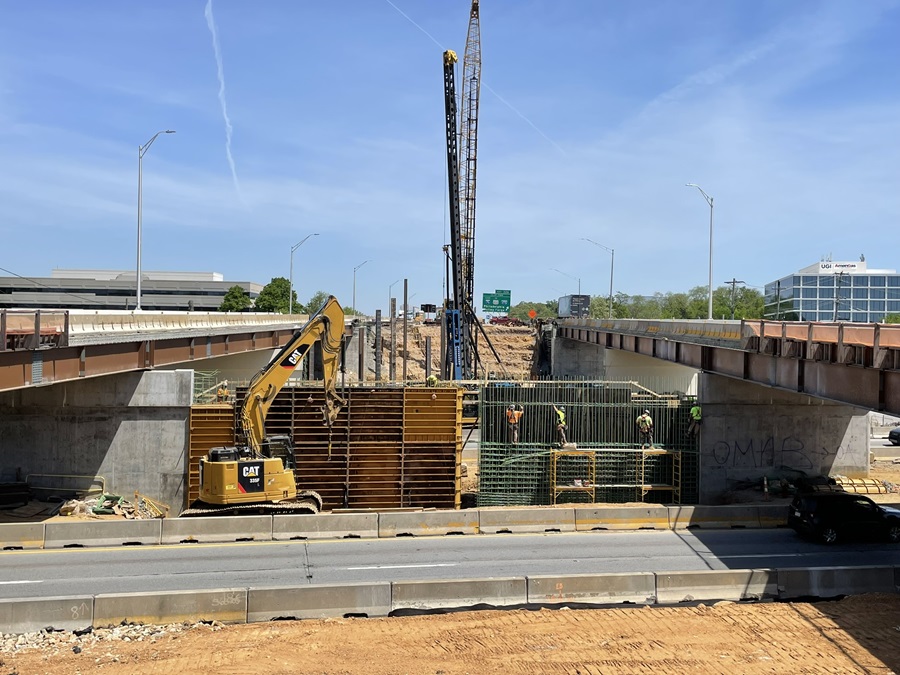

May 2024 - Workers construct a pier for the new Turnpike bridge over U.S. 422
May 2024 - Beams placed on the center of the new bridge over Glenhardie Road
May 2024 - A long view of the center construction area
March 2024 - Construction of the center area of the Turnpike bridge over Glenhardie Road
March 2024 - Reconstruction of the center area of I-76
March 2024 - Workers reconstruct the center portion of the bridge carrying I-76 over U.S. 422 and N. Gulph Road
February 2024 - Construction of the westbound side of the new bridge carrying the Turnpike over U.S. 422 and N. Gulph Road
February 2024 - With the old pavement removed, reconstruction of the center area of I-76 is progressing from east to west
February 2024 - Broken concrete is recycled on-site for reuse as the base of the new pavement
February 2024 - Recycled concrete that was ground on-site for reuse as the base of the new pavement
December 2023 - Reconstruction of the center area of the Turnpike for the project's second stage began in late fall 2023
December 2023 - Reconstruction of the center portion of the Turnpike bridge over U.S. 422 and N. Gulph Road
December 2023 - The Stage 2 traffic pattern shifted motorists onto the reconstructed outer lanes to allow for center area reconstruction
October 2023 - Paving, grading, and soundwall installation on the eastbound side of the Turnpike near the Valley Forge Service Plaza
October 2023 - Paving operations on the westbound side of the Turnpike
October 2023 - Paving operations on the westbound side of the Turnpike
September 2023 - Sound wall installation is expected to be completed in fall 2023
September 2023 - The new retaining wall on the westbound side of the Turnpike
September 2023 - Construction of the new bridge carrying the Turnpike over Glenhardie Road
September 2023 - Paving completed on the outer section of the new bridge carrying the Turnpike over U.S. 422/N. Gulph Road
July 2023 - A long view of the westbound work area
July 2023 - The eastbound work area near Glenhardie Road
July 2023 - A crew finishing the sound wall panels along the eastbound Turnpike
June 2023 - Deck beams in place for the new bridge over Glenhardie Road
June 2023 - Retaining wall construction on the eastbound side of the Turnpike was completed in spring 2023
June 2023 - Construction of a retaining wall on the westbound side of the Turnpike, which when completed, will look similar to the previous picture
June 2023 - Concrete curing blankets in place after paving the new bridge over U.S. 422
June 2023 - Sound wall installation on the eastbound side of the Turnpike
March 2023 - Glenhardie Road Bridge construction
March 2023 - U.S. 422 bridge construction
March 2023 - New sound walls installed alongside the westbound side of the Turnpike
March 2023 - New beams and abutments for the bridge over Thomas Road
February 2023 - Workers construct a wing wall for the new Thomas Road Bridge
February 2023 - Support of excavation in place for the construction of a retaining wall
February 2023 - Sound wall posts in place along the eastbound side of Turnpike
January 2023 - Posts in place for the later installation of sound wall panels along the eastbound Turnpike
January 2023 - Pumping concrete along the eastbound Turnpike
December 2022 - Sound wall construction along the westbound side of the Turnpike
December 2022 - Construction of a section of the Thomas Road bridge
December 2022 - Abutment construction of the eastbound bridge over U.S. 422
December 2022 - Excavation for the drainage basin along the eastbound Turnpike
December 2022 - Construction of the eastbound U.S. 422 bridge
October 2022 - Thomas Road overpass foundation construction
October 2022 - Excavation for the new Valley Forge Service Plaza ramp
September 2022 - Thomas Road overpass construction
September 2022 - Sediment basin excavation and grading
July 2022 - One of two new box culverts on the westbound side
July 2022 - Excavation on the westbound side
July 2022 - Construction of the new bridge over U.S. 422
July 2022 - Driving piles for the new bridge over U.S. 422
July 2022 - Drainage installation on the westbound side
July 2022 - One of the two new box culverts installed beneath the Turnpike
July 2022 - Excavation on the eastbound side
May 2022 - One of the two new culverts under construction
May 2022 - U.S. 422 bridge demolition
May 2022 - U.S. 422 bridge demolition
May 2022 - Workers in a trench box for drainage excavation
May 2022 - Construction near the Thomas Road overpass
March 2022 - Demolition of the south side of the bridge over U.S. 422
March 2022 - Nightime demolition of the bridge over N. Gulph Road
February 2022 - The existing overpass at Thomas Road
February 2022 - Construction on the westbound side
February 2022 - Excavation during culver replacement on the eastbound side
February 2022 - Grouting to stabilize soil on the eastbound side
December 2021 - Setting up the westbound construction zone
December 2021 - U.S. 422 bridge prior to demolition
