Design & Construction Details

Southern Beltway Design & Construction Details
  • Project Overview
  • Design & Construction Details
  • News & Public Involvement
  • Team & Contact Info

SR 980 Drainage Project

SR980 map

The PA Turnpike Commission (PTC) has awarded a $3 million contract to Plum Contracting, Inc., based in the Pittsburgh region, for the drainage work to be performed along State Route 980 in McDonald Borough, Washington County.

The contract calls for Plum Contracting to perform the work necessary to construct drainage improvements and perform channel restoration and stabilization along a tributary that flows into Robinson Run. The work will include but not be limited to replacing and correctly installing drainage pipe with up-to-code materials, restoring the open channel, coordinating with utility companies, as well as repaving the roadway.

The work is scheduled to begin in September 2022 and will include daylight operations. The contractor tentatively will work four, ten-hour shifts, Monday through Thursday, but may work additional hours if needed.

This work schedule is subject to change based on the weather conditions, but the project is expected to be finished by fall of 2023.

Construction Started
September 2022

Construction Completed
Fall 2023



Laurel Hill Road intersection

Laurel Hill Road Intersection - September 2022

Temporary protective fence

Temporary protective fence - September 2022

Compost filter sock 12 inch CF-13

Compost filter sock 12-inch - October 2022

Clearing and grubbing parcel 635

Clearing and grubbing - October 2022

24-inch gate valve

24-inch gate valve - October 2022

24 inch DIP backfill compaction

Backfill compaction for 24-inch Ductile Iron Pipe - October 2022

End of shift fencing

End of shift fencing - November 2022

66 inch RCP delivered to site

66-inch Reinforced Concrete Pipe delivered to site - November 2022

66" Pipe Trench

66" Pipe Manhole MH-304A - December 6, 2022

66" Pipe Panhandle Trail Crossing

66" Pipe Panhandle Trail Crossing - December 6, 2022

Panhandle Trail MPT - December 6, 2022

66" Pipe Crossing at Johns Avenue - December 13, 2022

Lifting 66" Concrete Pipe Sections - December 20, 2022

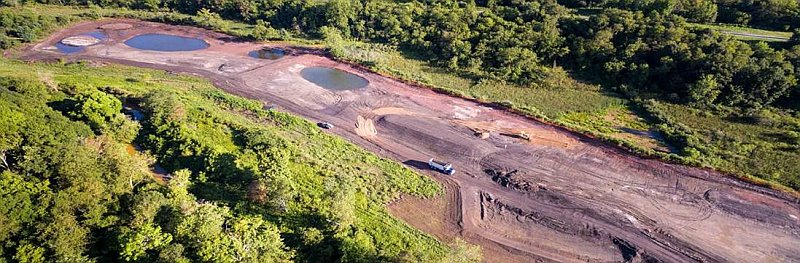

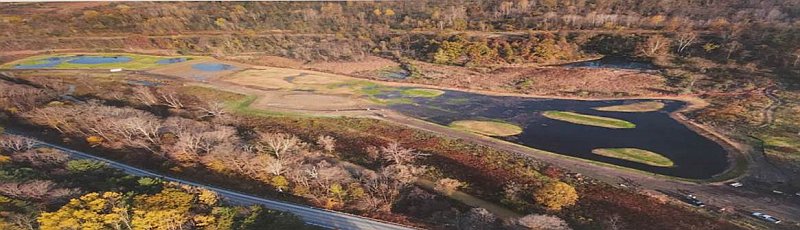

Completed Channel - May 2023

Completed Channel - May 2023

Final Seeding of Channel - May 2023

Final Seeding of Channel - May 2023

Johns Ave Paving - May 2023

Johns Ave Paving - May 2023

Work Completing on Johns Ave - May 2023

Work Completing on Johns Ave - May 2023

Asphalt Paving - May 2023

Asphalt Paving - May 2023

66" Reinforced Concrete Pipe Inlet - January 2023

66" Reinforced Concrete Pipe Inlet - January 2023

66" Reinforced Concrete Pipe Inlet - January 2023

66" Reinforced Concrete Pipe Inlet - January 2023

Inlet Flowable Fill Backfill - January 2023

Inlet Flowable Fill Backfill - January 2023

Stream Mitigation - January 2023

Stream Mitigation - January 2023

Stream Mitigation - January 2023

Stream Mitigation - January 2023

Stream Mitigation Boulder Sill No 9 - January 2023

Stream Mitigation Boulder Sill No 9 - January 2023

48" Pipe Adjacent to SR980 - February 2023

48" Pipe Adjacent to SR980 - February 2023

48" Pipe Headwall - February 2023

48" Pipe Headwall - February 2023

Service Water Line Installation - February 2023

Service Water Line Installation - February 2023

Unearthed Waterline Adjacent to SR980 - February 2023

Unearthed Waterline Adjacent to SR980 - February 2023

Stream Mitigation Channel - February 2023

Stream Mitigation Channel - February 2023

Stream Step Pool - March 2023

Stream Step Pool - March 2023

Channel Excavation East of SR980 - March 2023

Channel Excavation East of SR980 - March 2023

New Manhole Construction - March 2023

New Manhole Construction - March 2023

Twin Elliptical Pipes - March 2023

Twin Elliptical Pipes - March 2023

Twin Elliptical Pipe Headwall Location - March 2023

Twin Elliptical Pipe Headwall Location - March 2023

Permanent Waterline Connection - April 2023

Permanent Waterline Connection - April 2023

SR 980 Asphalt Patch - April 2023

SR 980 Asphalt Patch - April 2023

Elliptical Headwall - April 2023

Elliptical Headwall - April 2023

Final Grading Above Headwall - April 2023

Final Grading Above Headwall - April 2023

Final Grading - April 2023

Final Grading - April 2023

Seeding and Planting Complete - April 2023

Seeding and Planting Complete - April 2023

Laurel Hill Road intersection
Temporary protective fence
Compost filter sock 12 inch CF-13
Clearing and grubbing parcel 635
24-inch gate valve
24 inch DIP backfill compaction
End of shift fencing
66 inch RCP delivered to site
66" Pipe Trench
66" Pipe Panhandle Trail Crossing
Completed Channel - May 2023
Final Seeding of Channel - May 2023
Johns Ave Paving - May 2023
Work Completing on Johns Ave - May 2023
Asphalt Paving - May 2023
66" Reinforced Concrete Pipe Inlet - January 2023
66" Reinforced Concrete Pipe Inlet - January 2023
Inlet Flowable Fill Backfill - January 2023
Stream Mitigation - January 2023
Stream Mitigation - January 2023
Stream Mitigation Boulder Sill No 9 - January 2023
48" Pipe Adjacent to SR980 - February 2023
48" Pipe Headwall - February 2023
Service Water Line Installation - February 2023
Unearthed Waterline Adjacent to SR980 - February 2023
Stream Mitigation Channel - February 2023
Stream Step Pool - March 2023
Channel Excavation East of SR980 - March 2023
New Manhole Construction - March 2023
Twin Elliptical Pipes - March 2023
Twin Elliptical Pipe Headwall Location - March 2023
Permanent Waterline Connection - April 2023
SR 980 Asphalt Patch - April 2023
Elliptical Headwall - April 2023
Final Grading Above Headwall - April 2023
Final Grading - April 2023
Seeding and Planting Complete - April 2023

Section U.S. Route 22 to I-79

Opened October 2021 with ongoing improvements into 2023

Record of Decision

55A1 Map

55A1 U.S. Route 22 to Quicksilver Rd

Section 55A1 Construction Section of the Southern Beltway (PA Turnpike 576) runs from U.S. Route 22 to Quicksilver Rd. in Robinson Township, Washington County. Independence Excavating finished the approximate four-mile section, which contains one full interchange at Beech Hollow Road, three mainline bridge structures and one overpass. Beech Hollow Road and State Route 980 were realigned to create an intersection with Donaldson Road. Candor Road was reconstructed to include the overpass structure. The bridge structures carry PA Turnpike 576 over Little Raccoon Creek and Quicksilver Road. This portion of the project required nearly five million cubic yards of excavation.

Construction Started
December 15, 2016

Construction Completed
June 2019

Travel Details
I-576 is now open to traffic.

55A2 Map

55A2 U.S. Route 222 to Quicksilver Road to Panhandle Trail

U.S. Route 22 to Quicksilver Road to Panhandle Trail Section 55A2 located between sections 55A1 and 55B in Washington County is approximately 2.7 miles in length and includes:

  • Four precast concrete box culverts
  • One single-span precast concrete arch bridge
  • One single-span composite prestressed concrete PA bulb-tee beam bridge
  • Dual single-span composite steel multi-girder bridges
  • Dual eight-span composite steel multi-girder bridges
  • One full interchange
  • Reconstruction of State Route 980, State Route 4037 (Fort Cherry Road), and State Route 4012 (Noblestown Road)
The project requires more than three million cubic yards of excavation and includes a new connector road that will link Fort Cherry and Noblestown roads to State Route 980.



Construction Started
Mid-December 2018

Construction Completed
June 2021

Travel Details
I-576 is now open to traffic.

55B Map

55B Panhandle Trail to Cecil Reissing Rd



Panhandle Trail to Cecil Reissing Rd. PA Turnpike 576: This section is approximately 3.2 miles in length and required nearly six million cubic yards of excavation. The project includes a five span bridge that is 1,370 feet in length over State Route 980. The northern leg of Reissing Road was relocated and became Laurel Hill Road, and the southern leg has a new connection to State Route 980. Realignment of the Reissing and Profio Road intersection is also included.

Construction Started
February 2017

Construction Completed
December 2019

Travel Details
I-576 is now open to traffic.

55c1-1 maps

55C1-1 Cecil Reissing Rd to State Route 50

Cecil Reissing Rd. to State Route 50 to PA Turnpike 576, Section 55C1-1: Adjacent to Section 55B, is approximately 2 miles in length, and required nearly four million cubic yards of excavation. The project includes 4 bridges, two that span State Route 50, Wheeling and Lake Erie Rail line, and Millers Run Creek Road. A third bridge connects Cecil Reissing Road to State Route 50; north of its current location. The fourth bridge serves as the overpass for Cecil Sturgeon Road over PA Turnpike 576 (as part of the interchange) and provides a new connection with Reissing Road. The new interchange is located approximately one mile west of State Route 50 and includes four ramps connecting with PA Turnpike 576.

Construction Started
November 2017

Construction Completed
November 2020

Travel Details
I-576 is now open to traffic.

55C1-2

55C1-2 State Route 50 to Coal Pit Road

The 55C1-2 Construction Section of the Southern Beltway (PA Turnpike 576) runs from State Route 50 to Coal Pit Road in South Fayette Township, Allegheny County. Trumbull Corporation finished the approximate two-mile section, which contains a crossing of Hickory Grade Road over PA 576 and approximately 3 million cubic yards of excavation.

Construction Started
April 5, 2018

Construction Completed
June 2020

Travel Details
I-576 is now open to traffic.

interchange map 1

55C2-1 Route 50 to I-79 Including Interchange with PA Turnpike 576

PA Turnpike 576, Section 55C2-1: The project extends from approximately one mile west of I-79 in Allegheny County through an interchange connecting PA Turnpike 576 with I-79 and ends at Morganza Road just north of Cecil-Henderson Road in Washington County. The construction of the interchange includes the partial reconstruction of I-79 from the Southpointe Road Interchange to Alpine Road. The project also includes two miles of PA Turnpike 576 mainline construction, three miles of I-79 reconstruction, seven interchange ramps, four bridges, two bridge widenings and two, new intersections with PA Turnpike 576 ramps and Morganza Road. Approximately six million cubic yards of earth have been moved for the construction. There are three southbound I-79 lanes from Alpine Road to the Southpointe Interchange and a free-flow interchange between I-79 and PA Turnpike 576.

Construction Started
April 4, 2019

Construction Completed
Summer 2022

Travel Details
I-79 northbound and southbound lanes are in their final configurations and are open to traffic.  Final dress up work continues in these lanes with intermittent night time restrictions and an active work zone speed limit of 45 MPH.  This work is expected to continue through the middle of September. Rest areas both northbound and southbound are open.

The full interchange is now open to traffic, allowing access on all ramps open between the two limited access highways.




interchange map 2
Shoulder replacement on Ramp 79S to 576W

Shoulder replacement on Ramp 79 South to 576 West - October 2022

Slab replacement Ramp 79 S to 576 W

Slab replacement Ramp 79 South to 576 West - October 2022

Reclaiming former field office site

Reclaiming former field office site - October 2022

Installing fence at Basin B-25

Installing fence at Basin B-25 - October 2022

Concrete pavement slab replacement on Ramp 79N to 576W

Concrete pavement slab replacement on Ramp 79N to 576W - September 2022

Basin B-2 conversion

Basin B-2 conversion - September 2022

Emergency crossover on PA Turnpike 576

Emergency crossover on PA Turnpike 576 - September 2022

Straight edge testing asphalt at bridge approach on I-79 southbound

Straight edge testing asphalt at bridge approach on I-79 southbound - September 2022

I-79 all lanes opened to traffic

I-79 all lanes opened to traffic - August 2022

I-79 NB

I-79 Northbound - August 2022

Setting pre cast concrete barrier on I-79 Median

Setting pre-cast concrete barrier on I-79 median - August 2022

Basin B-1 Conversion - August 2022

Basin B-1 Conversion - August 2022

Slipform concrete barrier I-79 southbound

Slipform of concrete median barrier I-79 southbound - July 2022

Southbound over I-79

Looking southbound over I-79 - July 2022

Morganza Slope construction

2 to1 Slope construction along Morganza Road - July 2022

Turnpike 576 looking east

Turnpike 576 looking east - July 2022

Opening Ramp MRD0576W

Opening of ramp MR_D and ramp 576W_79N - December 2021

576 pre opening

576 eastbound preparing for the road opening - October 2021

Flume pipe

Pumping flow fill to flume pipe - November 2021

576 Overview from Morganza Road

Overview of PA Turnpike 576 from Morganza Road - October 2021

I-79 Traffic Pattern

New traffic pattern on I-79 southbound

SB-292 Beam Erection

Bridge Beam Erection SB-294 - October 2021

Stream relocation excavation

Excavation for stream relocation - November 2021

Morganza Road Ramp

Ramp from Morganza Road to 576 west bound opening - December 2021

SB-149 Concrete Bridge Deck Placement

Concrete Placement for SB-149 Bridge deck - November 2021

I-79 south bound 55C2-1 shoulder area

Slipform paving the shoulder area on I-79 south bound - June 2022

Moment Slab on I-79 southbound

Placing concrete for Moment Slab on I-79 southbound - June 2022

SB-270 Bridge Deck Mechanical grooving

Mechanical grooving of SB-270 Bridge Deck - June 2022

Morgan Road Bridge

I-79 Looking South from Morgan Road Bridge - June 2022

Basin B-7 Conversion

Basin B-7 Conversion May 2022

Sign Structure Assembly

Assembly of Sign Structure on I-79 south bound - May 2022

Placing Concrete tie-in at Ramp 576

Placing concrete tie-in at Ramp 576 east to 79 north - May 2022

Slipform paving long life pavement

Slipform paving long life pavement for ramp 79 south to 576 east - May 2022

Placing cement treated permeable base on I-79 SB

Placing cement treated permeable base on I-79 SB - April 2022

Seeding and placing erosion control mulch blanket on slopes

Seeding and placing erosion control mulch blanket on slopes - April 2022

Basin B-2 Access Road

Basin B-2 Access Road - April 2022

Slipfrom paving I-79 SB

Slipform paving I-79 SB - April 2022

55C2-1 McPherson Stream Relocation - March 2022

McPherson Stream Relocation - March 2022

Placing concrete for Moment Slab on I-79 NB - March 2022

55C2-1 Placing concrete for Moment Slab on I-79 NB - March 2022

Slipform Paving Shoulder Ramp 79 S to 576 EB - March 2022

Slipform Paving Shoulder Ramp 79 S to 576 EB - March 2022

55C2-1 79N Moment Slab Barrier - March 2022

I- 79 N Moment Slab Barrier - March 2022

Concrete Bridge Deck Placement

Bridge Deck Concrete Placement Ramp I-79 SB to 576 EB over 576 EB & WB - May 2021

Bridge staining architectural treatment

Staining architectural treatment on bridge over PA Turnpike 576 - September 2021

I-79 Deck Placement

Ready for deck concrete placement on bridge ramp from I-79 to 576 eastbound over 576 eastbound and westbound May 2021

Community Meeting

The 55C1-2 Community Meeting was held on Tuesday, March 5, 2019

I-79 Traffic Switch

Preparing for traffic switch on I-79 northbound - August 2021

I-79 Traffic Split

Prepping for traffic split on I-79 northbound - July 2021

I-79 Slipform paving

Slipform paving I-79 Northbound - June 2021

Community Meeting

The Contractor Walsh Construction speaking during the Community Meeting - March 2019

SB-294 MSE Wing Wall

MSE Wing Wall SB-294 - September 2021

I-79 curved girder

Ramp I-79 to Turnpike 576 eastbound and Bridge over Turnpike 576 curved girder erection span 1 - December 2020

576 excavation overview

Turnpike 576 Excavation Overview - September 2019

MSE Wall I-79 northbound

MSE wall I-79 northbound bridge over South Pointe Blvd - July 2021

Boring under I-79

Boring under I-79 for Rest Area sewer line relocation - January 2021

Pier cap I-79 bridge

Forming pier cap for I-79 southbound bridge - February 2020

Profiler checking pavement

Checking pavement smoothness on PA Turnpike 576 westbound with a light weight profiler - September 2021

I-79 Moment Slabs

Moment slabs I-79 median - July 2020

Footer concrete placement

Bridge abutment No. 1 footer concrete placement - January 2020

Epoxy overlay I-79 Bridge

Epoxy overlay completed and preparing for the traffic switch on I-79 Bridge over Cecil Henderson Road - November 2020

Soil nail retaining wall B-275

Temporary shoring soil nail retaining wall I-79 for SB-275 Bridge construction - August 2019

SB-289 Pier Footer

SB-289 Pier No. 1 Footer - September 2019

Beam Erection I-79

Beam Erection I-79 over Southpointe Blvd - August 2021

I-79 Bridge Pier

I-79 Bridge over Cecil Henderson road - pier No. 1 cap - November 2019

SB-276

SB-276 - May 2021

Sediment Basni 2

Temporary Sediment Basin No. 3 - April 2019

I-79 Bridge Pier

I-79 Bridge over Cecil Henderson Road, Pier No. 2 - November 2019

Curved girder erection

Ramp I-79 to Turnpike 576 eastbound and Bridge over Turnpike 576 curved girder erection span 1 - December 2020

SB-275 excavation

SB-275 Excavation - July 2019

SIP Bridge Deck form

SIP bridge deck form installation Ramp I-79 southbound to 576 eastbound over 576 - March 2021

I-79 Mechanical coupler installation

I-79 Bridge over Cecil Henderson Road Mechanical Coupler Installation - October 2019

Transition benches

Eastbound cut and fill transitions benches - August 2020

Beam erection I-79SB

Beam erection I-79 southbound bridge over future Turnpike 576 - May 2020

Overview of I-79

Overview of I-79 looking south from County Line Road - April 2019

I-79 Slipform paving

Slipform concrete paving I-79 northbound - May 2021

Curvred girder bridge

Curved girder bridge beam erection for ramp from I-79 southbound to Turnpike 576 eastbound over Turnpike 576 - November 2020

I-79SB Bridge deck

Preparation for I-79 south bound bridge deck placement over PA Turnpike 576 - July 2020

Overhang SIP

Forming overhangs and SIP deck pans on I-79 southbound bridge over PA Turnpike 576 - June 2020

Erected Steel Beam

Erected steel beam for I-79 Bridge over Cecil Henderson Road - May 2022

County Line Road Overview

576 Overview from County Line Road - September 2021

Slipform paving

Slipform paving ramp I-79 northbound to 576 westbound August 2021

Bridge Deck Placement

Bridge Deck Placement I-79 northbound over 576 eastbound and westbound - June 2021

Community Meeting

Southern Beltway project map being viewed during the Community Meeting - March 2019

SB-289 Epoxy Overlay

SB-289 epoxy overlay northbound - July 2021

Slipform LLCP 576

Slipform long life concrete pavement 576 westbound - August 2021

I-79 Ramp Excavation

Excavation for ramp I-79 northbound to 576 westbound - April 2021

Box Culvert 576

576 Box Culvert - September 2019

endwall 84 pipes

D-W end wall for dual 84-inch pipes - November 2011

Community Meeting

Residents asking Questions during the Community Meeting - March 2019

MSE Wall I-79

MSE wall at abutment No. 2 of I-79 southbound bridge over Southpointe Blvd - June 2021

576 Excavation

576 Excavation - July 2019

I-79 Temporary Shoring

Temporary shoring for I-79 bridge at abutment No. 2 - February 2020

Temporary Sediment Basin

Temporary Sediment Basin No. 2

Bridge Deck Grooving

Mechanical grooving bridge deck I-79 northbound over 576 - July 2021

I-79 Pier cap forms

Setting pier cap forms for I-79 bridge - February 2020

Wingwall I-79 Bridge

Wingwall abutment No 2 of I-79 bridge over PA Turnpike 576 - June 2020

Rock Construction Entrance

Rock Construction Entrance off Countyline Road - March 2019

Slipform paving ramp 576

Slipform paving Ramp 576 westbound to I-79 southbound - April 2021

Montour Trail shielding

Montour Trail Protective Shielding - June 2019

SB-289 Cecil Henderson Road

SB-289 Cecil Henderson road over I-79 - October 2019

pumping concrete I-79 Bridge

Placing concrete with pump for pier cap of I-79 SB bridge over 576 - March 2020

Mobilizing Equipment

Mobilizing Equipment - March 2019

Beam erection I-79 Bridge

Span 1 beam erection I-79 northbound bridge over 576 - April 2021

Paving crossover I-79 Median

Paving crossover I-79 median - August 2020

MSE Wall

Wire basket-MSE wall-temporary shoring for I-79 bridge over PA Turnpike 576 - June 2020

I-79 Bridge abutment

Abutment No 1 of I-79 Bridge over Cecil Henderson Road - August 2019

I-79 forming rebar

Forming and rebar at pier No. 2 at I-79 bridge over Cecil Henderson road - November 2019

Excavation Turnpike 576

Turnpike 576 excavation at Morgan Road bridge - February 2021

Dual RCP 84"

Dual 84-inch Reinforced Concrete Pipe - September 2019

Crossover Paving I-79

Crossover Paving at I-79 - June 2019

Shoulder replacement on Ramp 79S to 576W
Slab replacement Ramp 79 S to 576 W
Reclaiming former field office site
Installing fence at Basin B-25
Concrete pavement slab replacement on Ramp 79N to 576W
Basin B-2 conversion
Emergency crossover on PA Turnpike 576
Straight edge testing asphalt at bridge approach on I-79 southbound
I-79 all lanes opened to traffic
I-79 NB
Setting pre cast concrete barrier on I-79 Median
Basin B-1 Conversion - August 2022
Slipform concrete barrier I-79 southbound
Southbound over I-79
Morganza Slope construction
Turnpike 576 looking east
Opening Ramp MRD0576W
576 pre opening
Flume pipe
576 Overview from Morganza Road
I-79 Traffic Pattern
SB-292 Beam Erection
Stream relocation excavation
Morganza Road Ramp
SB-149 Concrete Bridge Deck Placement
I-79 south bound 55C2-1 shoulder area
Moment Slab on I-79 southbound
SB-270 Bridge Deck Mechanical grooving
Morgan Road Bridge
Basin B-7 Conversion
Sign Structure Assembly
Placing Concrete tie-in at Ramp 576
Slipform paving long life pavement
Placing cement treated permeable base on I-79 SB
Seeding and placing erosion control mulch blanket on slopes
Basin B-2 Access Road
Slipfrom paving I-79 SB
55C2-1 McPherson Stream Relocation - March 2022
Placing concrete for Moment Slab on I-79 NB - March 2022
Slipform Paving Shoulder Ramp 79 S to 576 EB - March 2022
55C2-1 79N Moment Slab Barrier - March 2022
Concrete Bridge Deck Placement
Bridge staining architectural treatment
I-79 Deck Placement
Community Meeting
I-79 Traffic Switch
I-79 Traffic Split
I-79 Slipform paving
Community Meeting
SB-294 MSE Wing Wall
I-79 curved girder
576 excavation overview
MSE Wall I-79 northbound
Boring under I-79
Pier cap I-79 bridge
Profiler checking pavement
I-79 Moment Slabs
Footer concrete placement
Epoxy overlay I-79 Bridge
Soil nail retaining wall B-275
SB-289 Pier Footer
Beam Erection I-79
I-79 Bridge Pier
SB-276
Sediment Basni 2
I-79 Bridge Pier
Curved girder erection
SB-275 excavation
SIP Bridge Deck form
I-79 Mechanical coupler installation
Transition benches
Beam erection I-79SB
Overview of I-79
I-79 Slipform paving
Curvred girder bridge
I-79SB Bridge deck
Overhang SIP
Erected Steel Beam
County Line Road Overview
Slipform paving
Bridge Deck Placement
Community Meeting
SB-289 Epoxy Overlay
Slipform LLCP 576
I-79 Ramp Excavation
Box Culvert 576
endwall 84 pipes
Community Meeting
MSE Wall I-79
576 Excavation
I-79 Temporary Shoring
Temporary Sediment Basin
Bridge Deck Grooving
I-79 Pier cap forms
Wingwall I-79 Bridge
Rock Construction Entrance
Slipform paving ramp 576
Montour Trail shielding
SB-289 Cecil Henderson Road
pumping concrete I-79 Bridge
Mobilizing Equipment
Beam erection I-79 Bridge
Paving crossover I-79 Median
MSE Wall
I-79 Bridge abutment
I-79 forming rebar
Excavation Turnpike 576
Dual RCP 84"
Crossover Paving I-79
55c1-2

55C2-2 Morganza/Morgan Road Improvements

PA Turnpike 576, Section 55C2-2: Between I-79 and Morganza Road in Washington County, and adjacent to PA Turnpike project Section 55C2-1, is approximately one mile in length, and required over 750 thousand cubic yards of excavation. The project includes a new alignment for Morgan Road with two overpass bridges above I-79 and PA Turnpike 576, and a new roundabout at Morgan Road’s intersection with Morganza and Baker roads.

Construction Started
October 3, 2018

Construction Completed
July 2020

Travel Details
I-576 is now open to traffic. Morgan Road, Baker Road, Morganza Road, North Morganza Road, and South Morganza Road are open to public traffic.

55W Wetland Mitigation Site

Wetlands 55W Wetland Mitigation Site was completed by the contractor, Cast and Baker Corporation on December 6, 2016. The site is located approximately 3/4 of a mile northeast of Burgettstown PA, adjacent to State Route 4012, and west of Raccoon Creek in Washington County, PA. As a result of the construction of the Southern Beltway, 9 acres of new wetland has been constructed adjacent to an existing wetland.

The project involved the removal of approximately fifty thousand cubic yards of material, replaced with approximately nine thousand cubic yards of topsoil for wetland infiltration; reseeded and planted with specific vegetation/shrub plants that are designed to thrive in a wetland area.

The Wetland Mitigation Site area is adjacent to an existing wetland north of the site and is also adjacent to PA State Game Lands. The 55W mitigation project is in keeping with the PA Turnpike's commitment to utilizing Best Management Practices.

Construction Started
February 2014

Construction Completed
December 2016

wetland mitigation site wetland mitigation site

Section I-376 to U.S. Route 22

Completed October 2006

The Southern Beltway I-376 to U.S. Route 22 Project, also known as the Findlay Connector, was the first to be constructed and opened to traffic in October 2006. This project begins at the existing Pittsburgh International Airport Midfield Terminal Interchange on I-376. It then proceeds southward 6 miles to a new interchange with U.S. Route 22 between the existing Bavington and PA Route 980 interchanges. This project received environmental clearance, the Record of Decision, in May 1998. The total project cost was $238 million.

CASHLESS TOLLING CONVERSION
(Completed Summer 2018)

This project converted the Findlay Connector (Toll 576) to all electronic tolling by constructing overhead gantries outfitted with E-ZPass Scanners and high speed cameras. The cashless tolling plaza is located at Milepost S-2.60, approximately 1.1 miles west of the Westport Road Interchange, Exit 4. The former toll plazas at Exit 2 (U.S. Route 30), Exit 4 (Westport Road), and Exit 6 (U.S. Route 22) have been demolished. This work is part of the PA Turnpike’s transition to Cashless Tolling. Visit www.nocashzone.com for additional information about the Findlay Connector conversion and the overall Cashless Tolling Project.

Mon/Fayette Expressway and Southern Beltway Project Map

    mon/fayette map zoom in

    I-79 to Mon/Fayette Expressway

    This project begins with the interchange at I-79 near the Allegheny/Washington County line and proceeds approximately 12.5 miles eastward to a new interchange with the Mon/Fayette Expressway near Finleyville. The U.S. Army Corps of Engineers (USACE) issued a Record of Decision in May 2009. The Selected Alternative begins at Morganza Road at the proposed interchange to I-79 and continues in a south/southeasterly direction through Cecil, Peters, North Strabane, Nottingham and Union townships to a new interchange with Turnpike 43 south of Finleyville. The PTC will proceed with final design, right-of-way acquisition and construction of the project as funding becomes available.

    Record of Decision

    More Project Resources

    Project Overview

    Learn about the Southern Beltway Project.

    Learn More

    News & Public Involvement

    Learn how we stay connected with the public about this project.

    Stay Updated

    Team & Contact Information

    Learn about the team that we will work with to complete the work on this project.

    Contact the Team

    • About Us
      • Our Mission
      • Our Board of Commissioners
      • Commission Meeting Information
      • Our Executive Leadership
      • Design & Construction
      • PA Turnpike History
      • Investor Relations
      • Resource Library
      • Policies & Standards
      • Security & Fraud
      • About Us FAQs
    • News
      • Traffic Reports
      • The Road Ahead: Turnpike Newsletter
      • Stories from the Turnpike
      • Media Center
      • PA Turnpike Blogs
      • Right to Know Request
      • Law Enforcement Requests
      • Vehicle Registration Suspension Appeals
    • Responsibility Matters
      • Sustainability
      • Clean Water
      • Accountability
      • PA Mobility Partnership Reports
      • National Center for Missing and Exploited Children
      • Human Trafficking Awareness
    • Contract/PO Search
    • Careers
    • Contact Us
    • Site Map
    • Employee Login
    • Facebook
    • Twitter
    • Instagram
    • Linkedin
    • YouTube

    ©2025 The Pennsylvania Turnpike Commission
