Design Update
Stay up to date on the latest updates from our design activities.

Fall 2026 Update
Throughout fall of 2026, the Allegheny Mountain Realignment project team conducted environmental and engineering studies to better understand the project area. Much of this year’s fieldwork has now been completed, and the team will continue reviewing the information collected to help inform preliminary engineering.
What Property Owners Should Expect
- Field activities on the mountain have wrapped up for the season to accommodate the fall hunting season.
- Noise monitoring studies are continuing along State Route 160, Wambaugh Hollow Road, and Turnpike Road.
Above Ground Historic Resource Survey
- Purpose: To identify structures that are 45 years and older to evaluate their historic significance. Staff collected information on structure types and approximate date of construction.
- Fall Update: All fieldwork has been completed for the 2026 season. Additional field work may occur in the future.
Archaeology Field Studies
- Purpose: A team of four will identify the presence of sites with archeological importance within the project area.
- Activities:
- Walking survey, surface condition review, metal detection, hand excavation up to three feet, and soil screening
- The team will use cameras, handheld GPS units, handheld soil probe tools, metal detectors, shovels, and screens
- Fall Update: All fieldwork has been completed for the 2026 season. Additional field work may occur in the future.
Wetland & Stream Investigations
- Purpose: A team of up to four will locate and delineate the edges of wetlands and streams within the project area.
- Activities:
- Walking survey, wetland/stream boundary flagging, soil digging up to18 inches
- The team will use cameras, shovels and a soil auger
- Please note that flags may stay in place for a period of time as surveyors work behind the crews to survey the flag locations. The survey crew will remove the flags as their work progresses.
- Fall Update: All fieldwork has been completed for the 2026 season. Additional field work may occur in the future.
Noise Monitoring
- Purpose: A crew of up to four will monitor noise levels
- Activities:
- Placement of temporary noise monitors near homes, businesses and other receptors.
- The team will use portable acoustic monitors, and equipment may remain onsite for more than 24 hours.
- Fall Update: Noise monitoring studies are being conducted along SR 160, Wambaugh Hollow Road, and Turnpike Road.
Threatened & Endangered Species Studies
- Purpose: To study various species including bats and the Allegheny Woodrat
- Activities:
- Up to six people could be conducting this work depending on activity
- Activities include Mist netting, photography, radio telemetry, and cave mapping. Some night work may be included as part of this study.
- If night work is required, the project team will notify property owners ahead of time that there will be studies performed at night.
- Fall Update: All fieldwork has been completed for the 2026 season. Additional field work may occur in the future. Additional information regarding these studies is available in this blog post.
Community Facilities and Environmental Documentation
- Purpose: To identify community facilities and services within the project area
- Activities: A team of two will conduct windshield surveys and environmental data collection
- Fall Update: All fieldwork has been completed for the 2026 season. Additional field work may occur in the future.

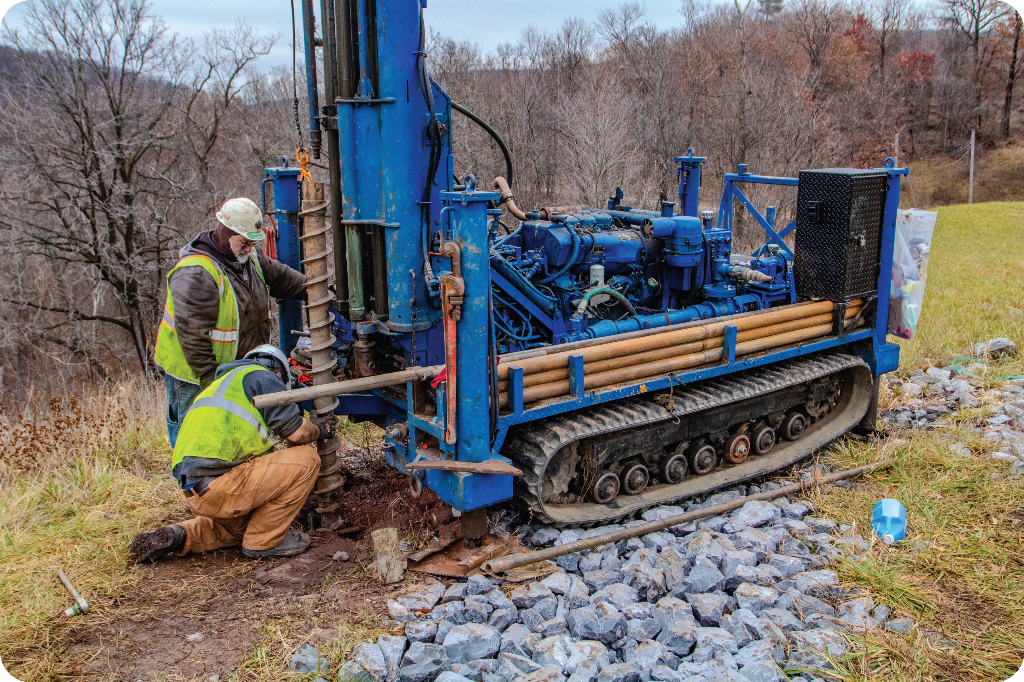

Geotechnical Drilling
- Purpose: To bore holes into the ground to collect soil and rock samples
- Activities:
- A team of up to three per track drill rig that will include geologists conducting soil and rock sampling
- Equipment being used includes track drill rigs, a water truck, backhoe or dozer for access and clearing or grubbing, storage for core boxes, and personal vehicles for crew and field geologists
- Fall Update: Work was completed this summer, additional follow-up work is anticipated in 2027.
Water Resources
- Purpose: A water quality monitoring plan is being developed to address concerns raised by the public, elected officials and project stakeholders. The program will include pre-construction, construction, and post-construction monitoring. Coordination with property owners and stakeholders within the project vicinity is expected to begin this summer.
- Activities: A team of up to two people will survey the area identifying, sampling and cataloging water sources.
- Fall Update: Fieldwork has been completed and the monitoring plan is under development.
Construction Management Services
- During the July 7, 2026, Pennsylvania Turnpike Commission Meeting, the Commissioners selected TRC Engineers, Inc. to provide Construction Management services for the Allegheny Mountain Realignment Project, providing construction expertise throughout the design process to identify potential challenges and develop a safer, more feasible and constructable design.
- Adding construction management services during the design phase, which has been done with other PA Turnpike projects, does not move construction closer or change the project's timeline.
