Allegheny Mountain Realignment - Overview

Traveling Construction Allegheny Mountain Realignment - Overview
  • Overview
  • News
  • Improvements
  • Engagement
  • Contact

Project Overview

The Allegheny Mountain Realignment Project: A Smoother, Safer Drive Is on the Way

The PA Turnpike is committed to bring important improvements to drivers traveling through Somerset County. The Allegheny Mountain Realignment project will create a new stretch of roadway just south of the Allegheny Tunnel, designed to enhance safety, ease congestion, and provide a more reliable travel experience for everyone. This investment in modern infrastructure will make trips more efficient while better preparing the region for future traffic needs.

Why This Project Matters

This project was carefully planned with safety at the forefront, as well as convenience in mind. The new alignment will help:

  • Reduce the number and severity of crashes near the Allegheny Tunnel

  • Eliminate the need to reroute vehicles carrying hazardous materials

  • Support current and future traffic levels

  • Minimize environmental impacts

By building a safer and more direct route, we’re working to reduce traffic backups and make travel easier for everyone in the area.

What’s Happening Now

Before choosing this new route, we took a close look at several options and selected the one that best met our goals for safety, mobility, and minimal environmental impact. The preliminary design phase started in March 2024, and the Bowman Consulting Group Team was brought on in 2023 to help bring this vision to life.

Design work is expected to take about nine years to complete. During this time, we’ll keep you informed and involved every step of the way.

Stay Connected

Want to stay up to date as the project moves forward?  Click here to fill out the contact information form to receive updates and important information.

Project Updates

Project updates will be sent directly to your inbox.

Sign Up Today

Design & Construction

Explore all active projects on the PA Turnpike.

Learn More

Take a Closer Look

Explore our latest overview highlighting key initiatives, progress, and benefits of this project.

Learn More

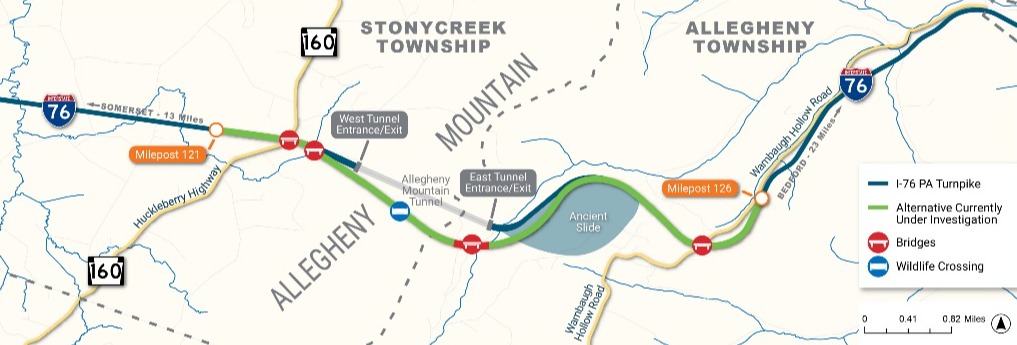

Project Map

AMR Map Oct 2025

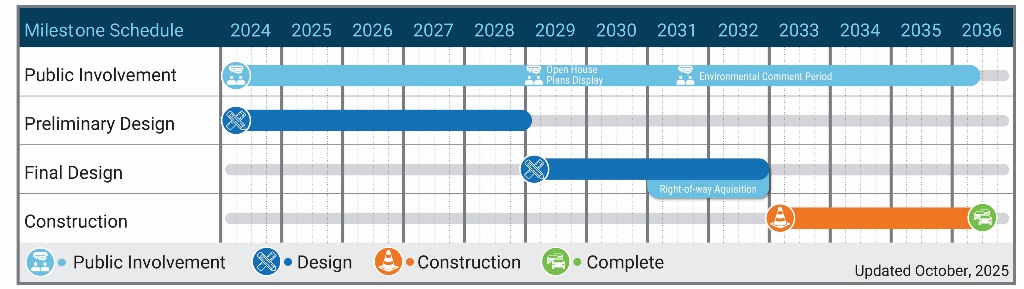

Project Schedule

AMR Schedule Oct 2025

These time frames are approximate and will be refined as the project advances.

Project FAQs

Where is the Allegheny Mountain Realignment Project?

The project is located approximately 13 miles east of the Somerset Interchange (Exit 110) and 23 miles west of the Bedford Interchange (Exit 146) on the Pennsylvania Turnpike. It spans the townships of Allegheny and Stonycreek in Somerset County. Please refer to the location map found on this website.

What is the purpose of the project and why is it needed?

The purpose of the project is to:

  • Improve safety and decrease accidents for motorists traveling through this section of the Turnpike.
  • Relieve traffic congestion and improve the level of service.
  • Improve system linkage and continuity for hazardous material carriers, which are not permitted in the tunnel.

Five needs are established for this project:

  1. Transportation Demand: The current and future transportation demands on the tunnel and its approaches result in an unacceptable Level of Service (LOS) and traffic congestion.
  2. Existing Geometric Constraints: Some geometric features of the tunnel and its approaches do not meet current highway design standards with respect to lane width, termination of truck climbing lane, horizontal curvature, and sight distance.
  3. Accident Rates: The accident rate for the tunnel and its approaches is higher than the entire Turnpike system and PennDOT statewide rates.
  4. Tunnel Conditions: Both the eastbound and westbound tunnels are in need of major rehabilitation.
  5. System Linkage and Continuity: Certain hazardous materials are not permitted through the Allegheny Tunnel. Travel on the Turnpike is currently disrupted because of diversion of hazmat haulers to local roads.

What is included in the Preliminary Design Phase?

The preliminary design phase is expected to continue into Q1 of 2029.

During this phase, the Project Team will refine the new roadway alignment, confirm environmental impacts, and work to minimize right of way impacts. Property owners adjacent to the Turnpike will receive formal notification letters regarding upcoming fieldwork in the project area. This includes surveyors affirming property lines, geotechnical engineers conducting more detailed soil testing, and environmental specialists conducting more detailed studies on wetlands, wildlife, farmlands, and historic resources in the area and how to mitigate impacts.

Team members may need access to property outside of the PA Turnpike's right of way to conduct this field research accurately, which is why you or your neighbors may receive a Notice of Intent to Enter letter. The preliminary design phase will conclude with a public meeting where the public can examine the proposed design plans and the additional right-of-way required by the project. The public will have the opportunity to provide comments, which will be recorded and considered during the final design phase of the project.

When will the extent of environmental impacts be identified, especially as it relates to the footprint, acid mine drainage, wildlife, wetlands, vegetation and streams?

Once preliminary engineering is completed in 2028, environmental impacts on the new alternative will be shared.

How was the alternative currently being investigated identified?

The gray cut alternative was identified because it best meets the project needs and balances environmental, engineering, operational, cost, and safety considerations. Numerous alignments were evaluated and presented to resource agencies, elected officials, and the public. The gray cut alternative was chosen as a result of environmental agency input during the study phase completed in 2021.
