Breezewood Interchange

Traveling Construction Breezewood Interchange

Interchange Project

  • Overview
  • News
  • Improvements
  • Contact

Field Work Notice

Field work for the Breezewood Interchange project is currently underway. Area residents may see project team members from the PA Turnpike and/or their project consultant team performing activities in and around the project area. The PA Turnpike sent Notice of Intent to Enter letters to property owners in the project study area in advance of field work activities.

PA Turnpike staff and consultant project team members will have proper identification and a copy of the Notice of Intent to Enter letters to present upon request when entering onto private, commercial, and/or residential property for field work. They will conduct their work expeditiously, courteously, and with minimal interruption to property access and/or use while project-related field work is in progress.

Project Overview

Breezewood Interchange – A New Chapter for a Historic Connection

The PA Turnpike is beginning an exciting new chapter for one of its most well-known interchanges – Breezewood. With aging infrastructure and new technology like Open Road Tolling (ORT) on the horizon, we now have a once-in-a-generation opportunity to completely reimagine the Breezewood Interchange—improving safety, traffic flow, and long-term mobility for travelers, businesses, and the surrounding community.

A new direct connection between the Turnpike (I-76) and I-70 will allow travelers passing through to remain on the interstate, while offering those visiting Breezewood and the Route 30 corridor a safer, less congested entrance into the community. In addition to improving traffic flow, the project supports local access and responds to long-standing requests from community leaders for improved connectivity.

Planning for the Future

The intent of a redesigned interchange will be to maintain local access to Route 30 in Breezewood, while also providing a direct connection from the Turnpike to I-70, addressing long-standing congestion and safety issues while making travel through the corridor faster and more efficient. In early 2025, the PA Turnpike selected Alfred Benesch & Company as the lead design consultant to begin preliminary and final design work for this transformational project.

Why It Matters

The Breezewood area plays a major role in Pennsylvania’s transportation system, connecting thousands of drivers each day. In 2022 alone, nearly 5.5 million vehicles entered or exited the Turnpike at Breezewood—and more than one-third of them were trucks. A new interchange design will help reduce delays, eliminate traffic signals along the interstate route, and support the growing demand for smoother, more reliable freight and passenger travel.

The Benefits You’ll See

  • Better traffic flow and less congestion

  • Improved safety for all travelers

  • More direct connections between major roadways

  • Reduced congestion and safer access to Breezewood and surrounding areas

  • Opportunities for economic development and growth

  • Cleaner air and a smaller environmental footprint

This project is in its early stages, but we’re committed to keeping the community informed every step of the way. As design progresses, we’ll continue to engage with local leaders, residents, and businesses for input on keeping Breezewood connected to the reconfigured interchange.

Stay Connected

Want to stay up to date as the project moves forward?  Click here to fill out the contact information form to receive updates and important project information.

Project Updates

Project updates will be sent directly to your inbox

Sign Up Today

Design & Construction

Explore all active projects on the PA Turnpike.

Learn More

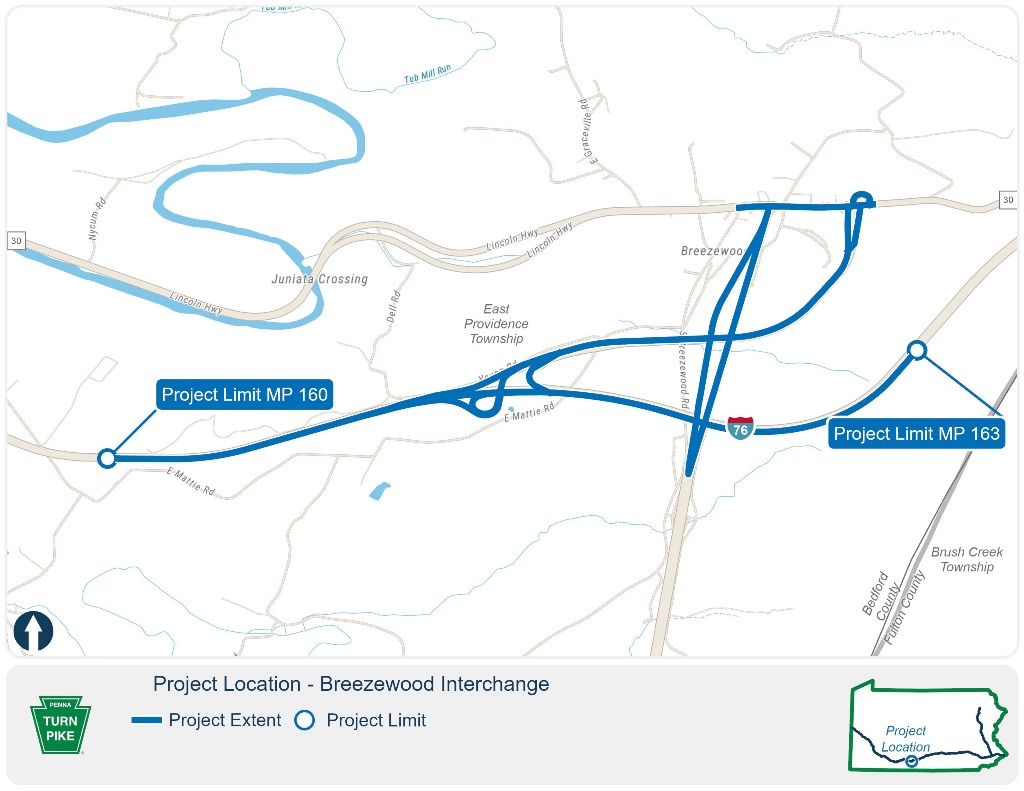

Project Map

Breezewood Interchange Project Map

Project Schedules

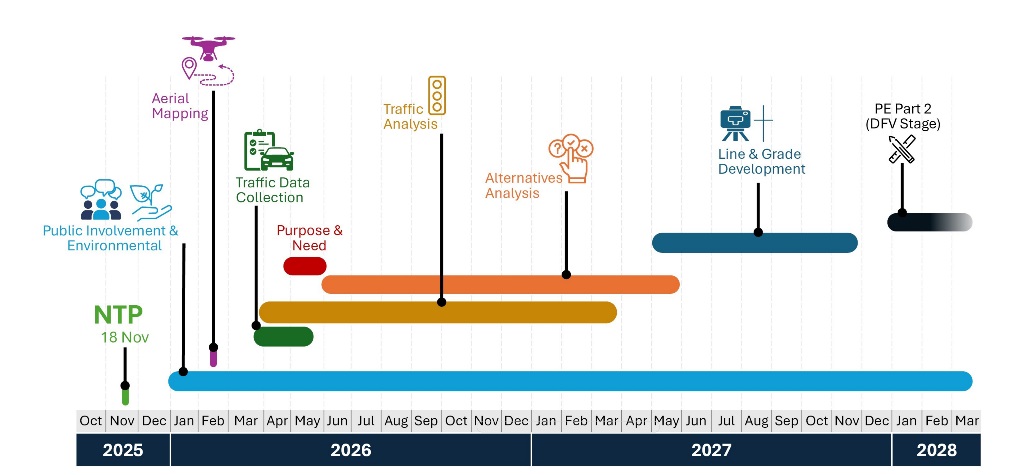

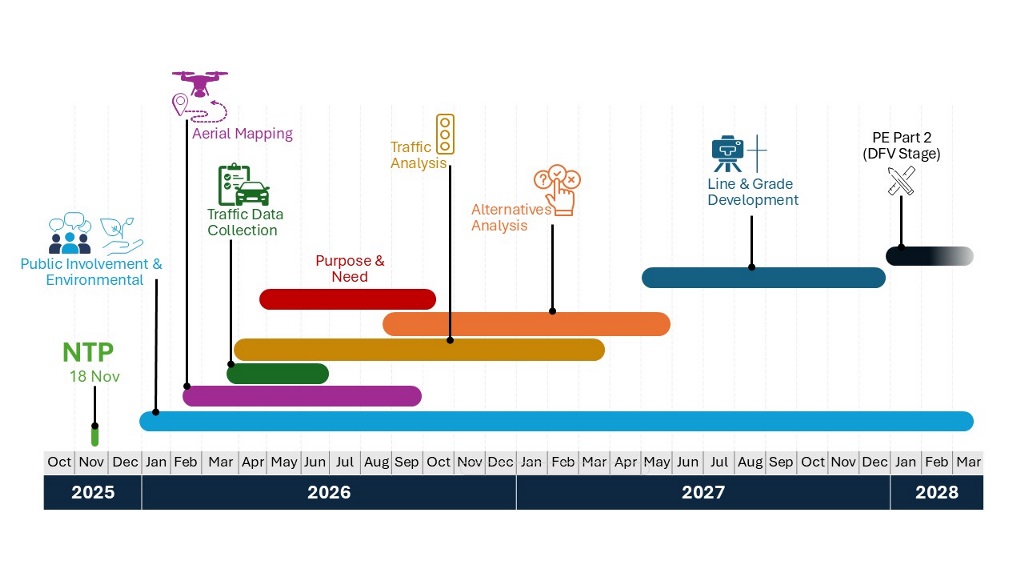

Phase 1 Preliminary Engineering

The timeline below features a detailed breakdown of activities performed during the first phase of preliminary engineering. Timeframes are approximate and will be refined as the project advances.

Breezewood Interchange Project Schedule

Project Design Schedule

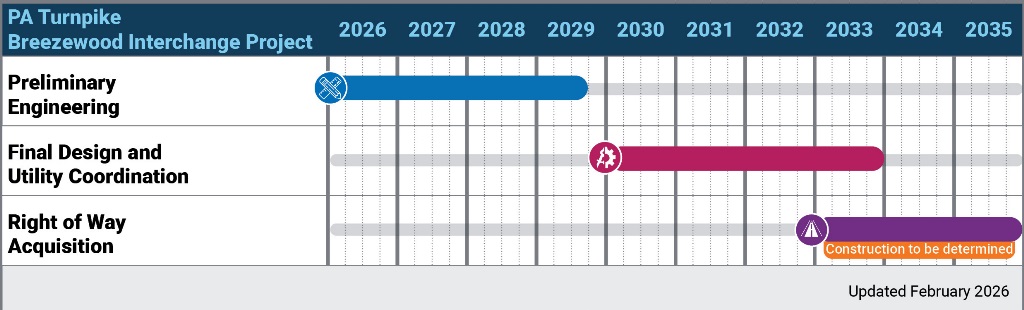

The timeline below focuses on the long-term project design schedule, comprising preliminary engineering, final design and right of way acquisition. Timeframes are approximate and will be refined as the project advances.

Breezewood Interchange Project Schedule

Project FAQs

Who can I contact with questions about this project? How can I get updates?

For project-related questions, please visit the Contact page. For all other questions/comments, contact the PA Turnpike.

How is the PA Turnpike considering effects to the environment?

The PTC coordinates with state and federal resource and regulatory agencies, as well as the public, to avoid or minimize impacts by the project where possible.
